Archive for the ‘Project Connect planning issues’ Category

h1

Let’s Fast-track a Plan for Urban Light Rail — and Make It Happen

31 December 2018

Map and graphics from Project Connect’s Feb. 2018 proposal illustrates possible 12-mile initial light rail line from Tech Ridge (at left end of map) routed south down N. Lamar-Guadalupe corridor to Republic Square in CBD (map is rotated 90°, with north to left and south at right). Other graphics show alignment design options and station attributes. Yet Capital Metro leadership has now withdrawn plan and restarted study process for another two years. Graphics: Project Connect.

by Lyndon Henry

This post is a publication of comments made by Lyndon Henry to the Austin City Council on 13 December 2018. Henry is a technical consultant to the Light Rail Now Project and a contributing editor to the Austin Rail Now website.

For decades, Austinites have been suffering the agonies of a worsening mobility crisis. Help has never been far away – over the past 30 years, no less than six official studies have come to the same conclusion: light rail transit, interconnected with an extensive bus network, is what’s needed.

But time after time, Austin’s leadership has failed to bring a single one of these plans to successful fruition. Austin has become the national poster child of analysis paralysis.

And now Capital Metro and its Project Connect planning program have restarted us on another re-iteration of this same exhausting process for a seventh time and another two years.

Transit advocates appreciate that Capital Metro has revised its Vision concept by restoring light rail and some additional corridors. But much more is needed.

Instead of backsliding to zero again, Capital Metro and the City of Austin need to fast-track this process by building on the data, analysis, community input, and other resources that have already recommended a light rail system and enhanced bus network as the way out of our mobility quagmire.

The Vision plan needs to become a lot more visionary. It needs to preserve a lot more corridors for future dedicated transit lanes. It needs to envision more and longer routes reaching out to serve other parts of the urban area.

Light rail can make this possible. It’s an affordable, cost-effective, off-the-shelf electric transport mode that’s well-proven in hundreds of cities and, best of all, it’s here today – we don’t have to wait for some science fiction technology. Austin needs a solution that’s available now.

Urban light rail is the crucial linchpin of a mobility plan because it has the power to make the whole system work effectively. It’s shown it has the true capacity to cost-effectively handle and grow Austin’s heaviest trunk routes, freeing up buses and resources to expand service into many more neighborhoods citywide. This advantage is validated by solid evidence – in average ridership and cost-effectiveness, cities with urban rail have significantly outpaced cities offering bus service only.

Yet even before Study No. 7 has begun, some Capital Metro and other local officials have been hinting they favor bus rapid transit (BRT) – basically a repackaging of bus service with minimalist capital improvements and lots of fanfare. But it’s unlikely BRT will provide the breakthrough Austin so desperately needs.

On average, compared to BRT, new light rail systems are carrying over three times the ridership at 10% lower operating cost. They’ve shown they can spark adjacent economic development and help shape urban density and growth patterns. BRT has shown almost no such benefits. And light rail comes without the toxic pollution and other problems of rubber tires.

Let’s leave the paralysis behind, and put a light rail starter line on a fast track for a vote in 2020.


An even more affordable light rail starter line project has been proposed by Central Austin Community Development Corporation as a 5.3-mile Minimum Operable System extending from the Crestview MetroRail station (at N. Lamar/Airport) to Republic Square. For a surface alignment with no major civil works, estimated cost in 2016 was less than $400 million. Graphic: CACDC.

Advertisements
h1

Let’s Put Austin’s Urban Rail Planning Back on Track

29 November 2018

Light rail starter line using N. Lamar-Guadalupe corridor from Tech Ridge to downtown was key element of Project Connect comprehensive regional plan presented in February 2018. Despite a three-year data-driven process with community participation, it was subsquently overruled and aborted by Capital Metro officials – setting back planning process another two years.

This post publishes the text of a handout distributed to a “Community Conversation” meeting sponsored by Project Connect in Council District 5 on 17 November 2018.

No more backsliding – Finalize a plan!

Last February (2018), Capital Metro’s Project Connect planning program, with public input, was finally nearing the end of a two-year process to devise a regional public transport proposal with urban rail and other “high-capacity” transit. On the table was a widely acclaimed, tentative plan for a viable, attractive public transport system, centered on a north-south light rail line from Tech Ridge to Slaughter Lane to link the city’s heaviest local travel corridors and provide a spine for ultimate rail extensions to other sections of the city. It was conceivable that details could be finalized to place a starter line on the November ballot for bond funding.

But that wouldn’t happen. Just over a month later, CapMetro’s new incoming CEO, with the blessing of the board, discarded the plan and reset the whole process back to zero – thus adding another two years to the seemingly endless effort to forge a transit remedy to Austin’s worsening mobility crisis.

While this destructive action was unprecedented and outrageous, for Austin it nevertheless fit a pattern of transit system plans aborted, botched, or abandoned by top leaders of CapMetro and the city’s political power elite, persisting over the past three decades. That’s a graveyard of at least six – count ‘em, 6 – urban rail planning efforts, totaling tens of millions of dollars, that have died because of official disinterest or misleadership, prolonging Austin’s mobility crisis pain and misery by 30 years. This delay needs to end – Austin needs to finalize and implement an urban rail system ASAP!

Real-world light rail, not science fiction dreams

In official studies from 1989 to 2018, light rail transit (LRT) has repeatedly been validated as Austin’s best choice for an attractive, cost-effective high-capacity transit system and the centerpiece of a regional system.

In recent decades, at least 19 North American cities have opened brand-new, affordable light rail systems that have typically excelled in attracting passengers, provided essential capacity and cost-effectiveness, and stimulated economic development that has more than repaid the public investment. Yet Austin’s official planning has recently been re-focused on visions of a totally untested, speculative technology (a “Smart Mobility roadmap” and ”Autonomous Rapid Transit”) – i.e., substituting science fiction for realistic, workable planning.

This seems basically a cover for dumping bona fide rapid transit and embracing a rebranded buses-only operation – bus rapid transit (BRT) – contradicting not only the recently aborted Project Connect process, but at least three official comparative studies over the past 28 years that have selected LRT as superior to BRT, particularly in key features such as capacity, ridership, cost, and economic development impacts. Disappeared from planning now are critical goals such as creating livable, transit-friendly, pedestrian-friendly streets and neighborhoods, and shaping public transit to guide growth and create economic investment.

Plans for urban rail should be fast-tracked

Austinites have long been suffering the pain of this region’s prolonged and worsening mobility crisis. We need real-world, proven, effective solutions nownot speculative visions of the possibilities of high-tech toys and autonomous vehicles. For sure, while prudently assessing new technology, we must not let our city be turned into a “Smart Mobility” Petri dish in lieu of installing a well-proven mass transit system such as LRT.

Austin’s mobility planning needs to be re-focused on developing an extensive, attractive, affordable, accessible, cost-effective public transport system with urban rail that can enhance livability, reduce total mobility cost, help guide growth, and encourage economic development that can recoup the public investment. To make up for time lost through delays and top-level debacles, rail planning should be fast-tracked, particularly by reinstating the results and community-participated planning decisions already achieved.

h1

Reorganized Project Connect 2.0 opens up, reaches out

30 April 2017

Guadalupe-Lamar corridor places at top of Project Connect’s table of corridor rankings shown in slide at April 26th MCAC meeting. Photo: L. Henry. (Click to enlarge.)

Has Austin’s public transportation planning and decisionmaking establishment turned a new leaf?

That’s yet to be fully determined. But … if Project Connect – the Capital Metro-sponsored major planning effort in charge of evaluating possible rail and other forms of “high-capacity transit” – offers any indication … there may be signs of a changed focus.

The original Project Connect earned intense distrust from Austin’s most ardent transit advocates because of its role leading the 2013-2014 High-Capacity Transit study that produced the disastrously flawed $600 million Highland-Riverside urban rail proposal (defeated by voters in November 2014). In contrast, the current planning agency (“Project Connect 2.0”) appears to have actually undergone a makeover in some important respects.

Personnel — A totally new planning team, with completely different personnel from the original Project Connect.

Consultants — A new consultant team led by AECOM.

Methodology — A focus on actual travel corridors rather than the original Project Connect study’s method of slicing up central Austin into districts and sectors and mislabeling them “corridors” and “subcorridors” … plus analytics that seem more accurate in evaluating and prioritizing corridors for a comprehensive plan.

Public involvement — What seems to be a much more sincere effort than in the past to solicit and engage actual involvement by key members of the community in the nuts and bolts of the planning process.

Included in this outreach have been strong advocates of urban rail for the Guadalupe-Lamar corridor. Invited to an April 17th consultory meeting, representatives of the Texas Association for Public Transportation (TAPT, sponsor of the Light Rail Now Project and this website) and the Central Austin Community Development Corporation (CACDC) were presented an overview of Project Connect’s planning process and its current status, which appeared to represent a new direction in goals and methodology and a somewhat new approach to public involvement.

Currently Project Connect is completing what it designates as Phase 1 of its overall analysis – concentrating mainly on evaluating and selecting corridors as candidates for possible “high-capacity transit”. Phase 2, according to the agency, about to begin, will focus on selecting modes (i.e., types of “vehicle” systems), identifying funding mechanisms, determining “the best set of solutions”, and recommending Locally Preferred Alternatives (LPAs).

At the April 17th meeting, the attendees were told that the Guadalupe-Lamar corridor was ranking quite high in the evaluation. They were encouraged to attend a public meeting of the Multimodal Community Advisory Committee (MCAC), set for April 26th, where the major results of Phase 1 would be presented.

And indeed, at the April 26th MCAC meeting, Project Connect team members, via a slide presentation led by the project’s Director of Long Range Planning Javier Argüello, revealed the study’s conclusion: Guadalupe-Lamar had emerged as the study’s top-ranked corridor. (At top of this post, see closeup of slide of ranking table.)


Project Connect’s table of corridor rankings shown in slide at April 26th MCAC meeting. Photo: L. Henry. (Click to enlarge.)


From here, according to the study timetable, the focus will narrow on possible modes (rail modes, buses, others) and comparative costs. Obviously, there’s no guarantee that light rail transit (LRT) on Guadalupe-Lamar – the center of substantial community interest for decades – will make the final cut.

Unfortunately, it’s possible that an evaluation could be impaired or skewed by false assumptions. For example: Buses in dedicated lanes may rate as a “high-capacity” mode, but they have not shown that they can attract passengers to utilize that capacity at a rate or level comparable to LRT. Also, LRT has shown a much higher propensity to attract adjacent development – particularly transit-oriented development, or TOD – than “high-capacity” bus services such as MetroRapid. And there are other significant performance and operational issues to consider.*

*See:
New light rail projects in study beat BRT
LRT or BRT? It depends on the potential of the corridor

Nevertheless, despite an array of critical differences, study methodologies and planning models frequently treat rail and bus modes as if they’re totally interchangeable in key features such as attracting ridership, accommodating future ridership growth, and stimulating economic development.

So will an adequate, fair, accurate comparison be conducted? Are local public transport planners actually starting to move in a new direction? The jury’s still out. But Austin’s staunchest transit advocates are watching … and hoping.

h1

Transit planning cabal-style

28 February 2017
Graphic: Marvel Database.

Graphic: Marvel Database.

In recent weeks, within Austin’s transit advocacy community, rumors have been circulating of some kind of “package” of major transit projects possibly being compiled, perhaps for the November 2018 election cycle. While details are murky – concocted behind the veil of a resuscitated Project Connect and the tightly shuttered enclaves of the high-level leadership consortium of Capital Metro, City of Austin, plus some Travis County and state officials – it is whispered that such a plan might include a “Guadalupe-Lamar project” as well as an expansion of the MetroRail regional railway, a highway-routed bus “rapid transit” (BRT) line, and other possible projects.

A “Guadalupe-Lamar project” sounds great – a starter light rail transit (LRT) line in the Guadalupe-Lamar (G-L) corridor would represent the crucial linchpin of an eventual LRT (urban rail) network for the entire metro area. But there’s no guarantee that LRT is the “project” behind the dark curtain. Whatever concrete details of these wisps of plans may exist seem to be closely guarded secrets. For the G-L corridor, officials, planners, and their consultants may be envisioning urban rail, or they might just as plausibly be concocting more investment in the pathetic MetroRapid faux-“BRT” operation … or a cable-gondola line … or some other scheme.

The problem is that this top-level methodology of secrecy is now the routine modus operandi of most of Austin’s major public transport planning. And this, in an era of so-called “transparency”.

In fact, a lot of this methodology comes close to the definition of a cabal: “the contrived schemes of a group of persons secretly united in a plot ….” While it doesn’t have the cohesiveness of a bona fide cabal – and it certainly isn’t motivated by evil intent – today’s transport planning process nevertheless feels enough like a behind-the-scenes cabal to merit this unfortunate comparison. (And that’s why we’ve dubbed it “cabal-style”.)

Local planning wasn’t always this Machiavellian. Back in the early days of the Austin Transportation Study (predecessor of CAMPO) and Capital Metro, particularly in the 1970s and 1980s, planning was upfront; plans were on the table for public review, discussion, and debate. Community activists were intimately involved in the planning process; public participation was vigorous and vibrant. Meetings of advisory bodies such as Capital Metro’s Citizens Advisory Committee and Transitway Corridor Analysis Project Advisory Committee were frequent and well-attended, often by participants in the dozens. Plan proposals were not only clearly on view, but were shaped and fine-tuned by direct community input.

That process has, in recent years, been squelched. Interactive public meetings have been replaced by “open houses” and “workshops” where actual full discussion among all participants is excluded. Austin Rail Now has analyzed and criticized this deleterious process in considerable detail – see the numerous articles collected in the category Public involvement process.

Bona fide, free-speaking, freely attended, full public meetings are a critical component of democratic process. That’s how ideas are raised, shaped, tweaked, finalized – via discussion within groups of participants with a diversity of expertise, backgrounds, viewpoints, insights.

You can be sure that these occult, mysterious transit plans we’ve been referring to have been hatched by vigorous interactive meetings … not of the public, but of a relatively tiny, cabal-like huddle of officials, planners, and consultants sheltered from public view and involvement. A carefully assembled community body like the Multimodal Community Advisory Committee is allowed an occasional glimpse of what’s already been decided elsewhere … and then, only every few months or so. Back in the days of the directly involved and intensely active public advisory committees, meetings were held several times a month (especially in the final stages of formulating plans).

Even through this dark, distorted process, perhaps acceptable plans will emerge that will be embraced by the Austin community. But don’t hold your breath. The absence of direct, intimate, ongoing, adequately engaged, fully democratic public participation seriously increases the risk of flawed outcomes and political problems.

h1

Capital Metro — Back to 1986?

30 November 2016
Ottawa Transitway (BRT) bus congestion in downtown, 2011. Bus congestion has persuaded Ottawa to launch LRT project, now under construction. The possibility of severe bus overcrowding in downtown Austin led Capital Metro board to reject a proposed BRT line in I-35 in favor of LRT in 1989.

Ottawa Transitway (BRT) bus congestion in downtown, 2011. Bus congestion has persuaded Ottawa to launch LRT project, now under construction. The possibility of severe bus overcrowding in downtown Austin (as warned by local community transit activists) led Capital Metro board to reject a proposed I-35 BRT line in favor of LRT in 1989. (Photo: Flickr.)

Austin’s Capital Metro seems determined to return to the thrilling days of yesteryear – at least in its longrange transit system planning.

That would appear to be the case, according to reports from participants in a meeting where representatives of Project Connect (unearthed from its grave by Capital Metro) presented the agency’s “priorities” for regional transit system planning.

The presentation, organized on the evening of November 15th by the Friends of Hyde Park neighborhood association, was reported by Austin community transit activist Mike Dahmus in Twitter messages and a posting on his blog. Mike’s report, with confirmation from other participants, makes it clear that some implementation of “bus rapid transit” (BRT) on I-35 is (in the words of one observer) a “foregone conclusion”. But this is a revival of a faulty 1986 plan from the agency’s past.

This proposal for “BRT” (i.e., express or limited-stop buses) on I-35 is basically a reversion to Capital Metro’s planning as of about 1986, at the start of the Transitway Corridor Analysis Project (TCAP). This early study effectively began with the premise that “BRT” was probably the desirable “rapid transit” mode for the region (although light rail was included in the TCAP study as a kind of whipping-boy target to be rejected). Just as with the agency’s current scheme, the 1980s-era “BRT” plans envisioned buses running in I-35. Feeding more buses into the I-35 alignment was to be the function of a northwestern branch; this was proposed as alternatives of running buses either in U.S. 183 or in a dedicated busway to be constructed along the new railway alignment (now the Red Line) that had been acquired by the City of Austin from the Southern Pacific Railroad.

Unfortunately for that “BRT” strategy, a number of savvy light rail transit (LRT) advocates were members of the TCAP Technical Group of Capital Metro’s then-very-active Citizens Advisory Committee, which met regularly (every two to three weeks or so) during the study process. Particularly knowledgeable about technical issues relating to the comparative evaluation of transit modes (e.g. issues from ridership forecasting to infrastructural, operational, and cost issues), community activist Dave Dobbs and public transportation planner Lyndon Henry were effective in responding to various claims and factual errors forthcoming from both Capital Metro staff members and consultants. The end result was a recommendation from the Technical Group for the Capital Metro board to approve LRT as the preferred mode, and subsequently (in 1989) the board did designate LRT as the agency’s Locally Preferred Alternative (LPA) for the central corridor.

What persuaded Capital Metro’s top decisionmakers to opt for LRT over the BRT plan? The most salient factors included:

• Evidence (plus intuition) that rail transit has greater public attractiveness and generates higher ridership than comparative bus systems …

• Unease over the difficulties and high investment cost of inserting BRT into a freeway alignment, and questions over the value per dollar spent compared with LRT …

• Perception and evidence that LRT tended to generate greater adjacent real estate and economic development than BRT …

• Overall perceptions that economic development plus total cost-effectiveness suggested a higher return on investment (ROI) for LRT …

• Concern over the possibility of bus overcrowding and even congestion on Central Area streets with the high-capacity BRT alternative …

• Conclusion that LRT would yield better compatibility (and fewer environmental impacts) with Austin’s urban environment than BRT.

Unfortunately, there’s no indication that any of these issues are being considered in the current Project Connect 2.0 study process, or emerging as a focus of attention on the part of today’s Capital Metro board.

And Capital Metro seems headed to repeat other past mistakes as well. Apparently, as related by Mike Dahmus’s blog report, the resuscitated “Project Connect 2.0” study process is also committing the same kinds of absurd, critical methodological errors that so thoroughly damaged the original “Project Connect 1.0” attempt to fashion a “High-Capacity Transit” (HCT) proposal in 2013. (See «The fraudulent “study” behind the misguided Highland-Riverside urban rail plan».)

For example, Mike reports:

The framework for discussion has been set in a way that heavily disfavors Guadalupe/Lamar rail. There are three ‘segments’ of travel they put up on the screen; as well as a slide which shows “previous HCT studies”. Guadalupe/Lamar is not in the top slide (most important service), nor is it listed in “previous HCT studies”. It is instead consigned to the second group, called “connector corridors”, implying that Capital Metro has already decided that it cannot be the spine of the transit network.

This kind of planning contortion – dissecting and severing major travel corridors into irrelevant “segments” – is exactly the kind of methodological butchery that in 2013 provided Project Connect 1.0 a rationale to dismiss the city’s most significant central urban travel corridor, Guadalupe-Lamar. Mike goes on to correctly explain that

… when the majority of your passengers on your theoretical ‘spine’ have to transfer, YOU HAVE A BAD SPINE, DAWG. Spines need to go down the middle and get to the good stuff. And especially on the ‘work end’ of the trip (not the ‘home end’): if a large percentage of your riders have to transfer off the spine, you’ve chosen poorly.

His blog post also quotes Houston urban planner and transit advocate Christof Spieler’s observation on the need to zero in on a city’s most important corridor:

For Houston, the strategy meant building a light rail through the city’s primary urban corridor, where lots of people already live and work.

Cities often shy away from that approach because it’s more expensive and disruptive to lay tracks in such populated locations. But the factors that make it difficult to build light rail there were exactly the things that made it the right place to have light rail.

Unfortunately, these key lessons seem lost on Capital Metro and its reanimated concoction Project Connect 2.0. Currently, the agency appears to be on course to once again disparage, downplay, and bypass the most important urban travel corridor in the city: Guadalupe-Lamar. ■

h1

The fraudulent “study” behind the misguided Highland-Riverside urban rail plan

4 November 2014

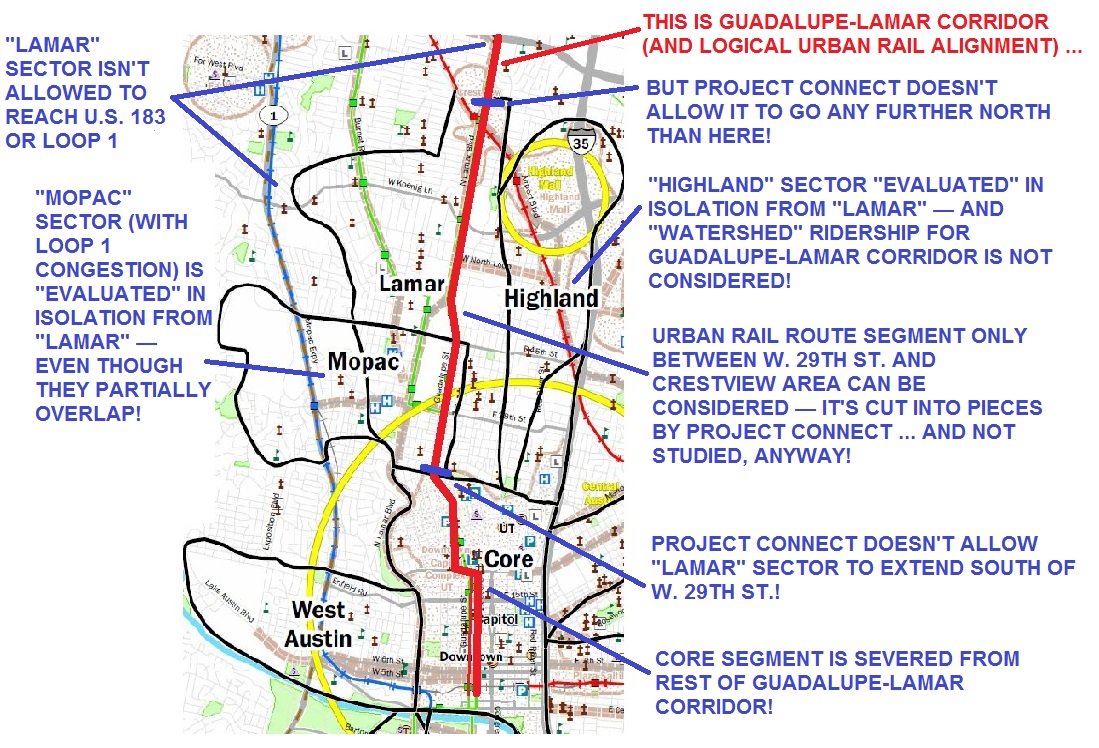

Infographic shows how Project Connect’s methodology segmented Guadalupe-Corridor into nonsensical pieces, and summarizes numerous other major problems. (Click to enlarge.)

Infographic map shows several major flaws of Project Connect methodology, applied to a portion of “study” area. Result was to skew results (and urban rail route) toward desired sectors of central city. Graphic: ARN. (Click to enlarge.)

Few local issues have been more divisive than the City of Austin’s 9.5-mile, $1.4 billion urban rail plan. Envisioned for a route that meanders from the Highland ACC area on the north to the East Riverside area on the southeast, the proposal is now on the Nov. 4th ballot as a $600 million municipal General Obligation bonds measure that would help fund slightly less than half of the projected investment cost.

Community skepticism — and puzzlement — about this rail project is widespread, but sponsors and supporters of it have repeatedly endeavored to bolster its credibility by describing it as the product of a “scientific”, “data-driven”, or “data-based” effort, a “high-capacity transit study” pursued by the Project Connect transportation agency consortium roughly between June and December 2013. However, as this website and numerous other critical sources have exhaustively documented, that “study” was basically a fraud.

It’s useful to review and summarize the origins of this seriously flawed rail plan as election day has come upon us. In particular, it’s important to keep in mind that the Project Connect “study” represents an object lesson in how not to conduct a study for a New Start rail transit project. This review will rely primarily on previous articles published contemporaneously on this website during the “study” exercise.

From Mueller to Riverside to Highland

As our recent article Derailing the Mueller urban rail express — Preamble to Project Connect’s 2013 “High-Capacity Transit Study” recounted, for years, local streetcar and then “urban rail” planning had focused on a starter line to the Mueller redevelopment project. There, the major urban development enterprise Catellus had been promised a rail transit link to help raise density limits, attract more property investors and homebuyers, and thus boost profits. Important also were the desires of the small but growing community of Mueller residents who expected a rail connection to jobs and other destinations.

However, for years the question had been repeatedly raised: Since the North Lamar-Guadalupe corridor was recognized as the city’s heaviest local arterial corridor, with the heaviest congestion — even used to justify the very need for urban rail in official presentations and documents — why was out-of-the-way Mueller targeted for the initial starter line investment? This inconsistency was the focus of our March 2013 article Why abandon Austin’s major corridor and congestion problem? which presented the following graphic, originally contained in a 27 January 2012 commentary by Lyndon Henry (now a contributing editor to this website):


xxxxxxx

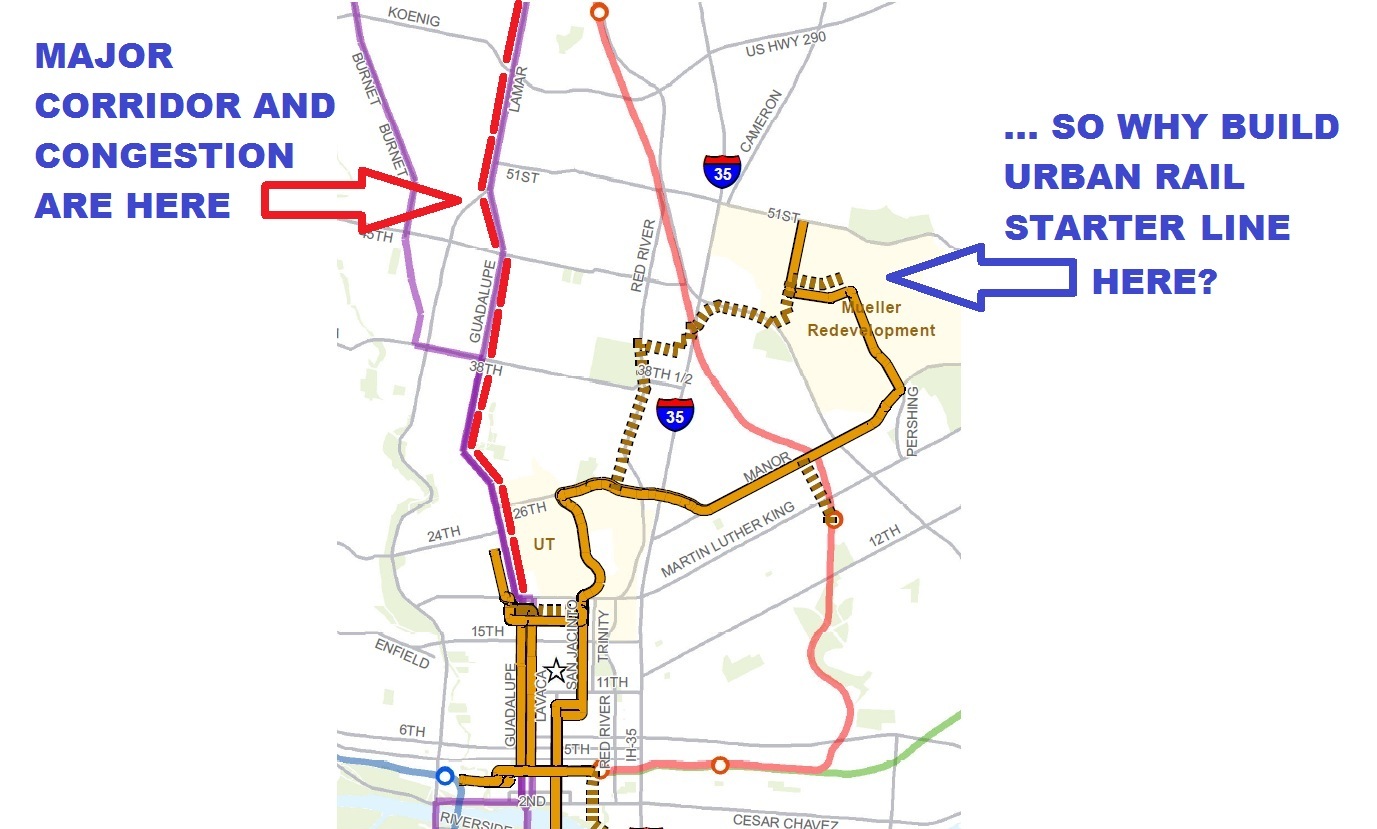

Graphic from 2012 suggested official emphasis on urban rail line to Mueller was misplaced, when real mobility need was in Guadalupe-Lamar corridor. Infographic: L. Henry.


As our “Derailing…” article, cited above, further recounts, the City of Austin/Project Connect pretext for continuing to plan an easterly, East Campus urban rail starter line to Mueller began to fall apart when the competency of a 2010 “Route Alternatives Evaluation” — the nominal basis for the plan then current — was questioned. Possibly other factors may also have begun to come into play (such as business community interest in exploring other development opportunities that could affect urban rail route planning).

In any case, the direction of rail planning shifted significantly. As our article noted,

In early 2013, Kyle Keahey was hired as Urban Rail Lead to head a new “High-Capacity Transit Study”, tasked with supposedly re-evaluating everything, racing through a process (with a presumably more competent and defensible methodology) that would result in a recommendation by the end of 2013.

Summary assessments of Project Connect “study”

Personnel associated with Austin Rail Now, the Light Rail Now Project, and other pro-rail organizations were involved intimately in following the planning activities of the “high-capacity transit” exercise from midsummer through the early winter of 2013. A number of our articles, particularly beginning in early November, chronicled revelations and realizations about the planning process as they emerged at the time.

However, a reasonable overview of the fundamental problems with the Project Connect exercise is provided in two of our articles in particular, each of them based on major commentaries by Lyndon Henry addressed to the Central Corridor Advisory Council (a group of community leaders hand-picked by Mayor Lee Leffingwell to review and approve work of the “study” team). These two articles, from early December 2013, together represent in essence an indictment of the competency and indeed the very legitimacy of the Project Connect exercise:

Memo to CCAG: “Pause” study or include “Lamar” sector

Project Connect Needs an Overhaul

What emerges is the sense of a process that was corrupted and skewed to render what, in hindsight, appears to be predetermined results — results seemingly contrived to justify a routing scheme for the proposed urban rail starter line project contrived to fulfill the aims and desires of City of Austin policy and various special interests. As our article Surprise! Mayor and Project Connect select same routes they wanted in the first place (17 November 2013) assessed the process, Project Connect’s “study” seemed to have

… numerous hallmarks of having been rigged, from a peculiarly contrived methodology that departs from longstanding professional practice, to cherry-picking of a highly questionable set of data elements and the exclusion of data indicators far more appropriate for such an ostensible “corridor study”. (And, one might add, a highly secretive and insular process that immunized the ProCon team and their study procedures from public scrutiny and oversight.)

Thus the basic flaw in ProCon’s data analysis can be boiled down to one word: GIGO (“Garbage In, Garbage Out”). In effect, this appears to have been a process that involved limiting the focus to gerrymandered data sources, and then playing games with gerrymandered data.

The task facing Kyle Keahey and the Project Connect team was daunting. The prevalent public sentiment strongly favored the Guadalupe-Lamar corridor for the urban rail starter line. Most Austinites sensed that Guadalupe-Lamar carried the heaviest traffic, served the highest density, and accessed the most key activity centers in the central city. Yet the City of Austin administration, Project Connect political leadership, and a major segment of local political and civic leaders desired a “study” outcome that would validate their economic and real estate development objectives. Project Connect’s effort would therefore have to try to convince the community, “Don’t believe your lying eyes.”

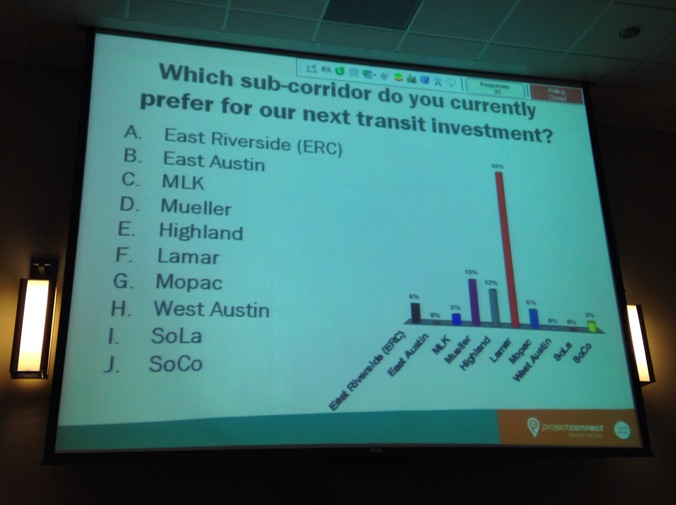

PowerPoint slide in Nov. 2013 Project Connect public presentation shows audience's overwhelming preference for "Lamar" — a proxy for the Guadalupe-Lamar travel corridor. Photo: Workingbird Blog.

PowerPoint slide in Nov. 2013 Project Connect public presentation shows audience’s overwhelming preference for “Lamar” — a proxy for the Guadalupe-Lamar travel corridor. Photo: Workingbird Blog.


Critical failings of the Project Connect “study” charade can be grouped into categories of practices. The following summaries of these practices include references to various ARN articles that may further illuminate these issues.

► Failure to examine travel corridors

Rather than zooming in on, and analyzing, actual travel patterns and density of travel in actual travel corridors within central Austin, the “study” instead carved out a great square of the central city, dubbed it the “Central Corridor” (although it contained multiple corridors in every direction), and then further subdivided this into a series of ten component sectors, some sprawling over considerable expanses of urban real estate. Since virtually the entire central city had been designated a “corridor”, these sectors were then dubbed “sub-corridors” — a kind of camouflage verbiage that masked the actual nature of what were in effect city neighborhoods or districts, not travel corridors. The “sub-corridor” designation also imparted a veneer of “transportation study” truthiness.

Our first analysis of this methodological problem, Project Connect’s “corridor” study — without corridors! noted that Project Connect’s subdivision of the study area in this way thus

… created an array of balkanized sectors that are analyzed more as autonomous geographic-demographic “islands” than as components essential to work together as a whole. As a result, actual, realistic, workable travel corridors have been obscured by all this.

Our article included a detailed explanation, with examples, of what urban travel corridors actually are, and how they should be treated and evaluated in a bona fide transportation corridor study. But, rather than corridors, Project Connect’s sectors (“sub-corridors”), we pointed out at the time, “resemble, to some extent, rather large travel analysis zones (TAZs, also called traffic analysis zones or transportation analysis zones).”

But, rather than TAZs for legitimate analysis purposes, we pointed out,

Project Connect’s sectors, in contrast, seem more designed to pit one part of the city against another — to function more as neighborhood enclaves to be assessed for their isolated demographics and “level of misery” (poverty, congestion, etc.) in a competitive showdown within a game of “Which sector deserves the urban rail prize?” It’s astounding that this charade is presented as a form of officially sponsored urban transportation planning.

Together with the agency team’s “seemingly heedless” segmentation of travel routes, their “treatment of adjacent sectors as insular, isolated enclaves, whose demographics and other characteristics apply only to themselves” was equally harmful to proper analysis. “Likewise travel characteristics are treated in isolation, as if the population in all these different ‘enclaves’ confine themselves to the sector boundaries that ProCon planners have established for them.”

Throughout the “study” process, we repeatedly returned to this problem. Our article Questions for Project Connect (3 December 2013), publishing questions which we raised in a “data dig” with Project Connect team members, asked “Why has this study avoided performing an actual corridor study, and instead spent its time (and taxpayers’ dollars) confined to undertaking a de facto inventory (and ‘beauty contest’) of various urban sectors in isolation?”

In our Memo to CCAG: “Pause” study or include “Lamar” sector (5 December 2013) we noted that “The basic methodology of focusing on sectors (so-called ‘sub-corridors’) meant that the study failed to study a single actual potential travel corridor in the study area.”

► Gerrymandered “study” sectors

Our Project Connect’s “corridor” study — without corridors! article, pointing out the peculiar boundaries applied to Project Connect’s weirdly sprawling sectors, described them as “gerrymandered”, and further experience confirmed this assessment. Our 17 November 2013 article Surprise! Mayor and Project Connect select same routes they wanted in the first place observed that

rather than performing a bona fide study of actual alternative corridors, ProCon embarked on what amounted to an inventory of highly filtered attributes of basically gerrymandered sectors, dubbed “sub-corridors”, devolving into a kind of “beauty contest” among sectors of the city, while distorting as well as ignoring the actual travel corridors that should have been the focus.

The article provides the example of the highly contrived “Highland” sector:

It should be noted that the “Highland” sector bears very little resemblance to the actual Highland neighborhood, delineated by both the Highland Neighborhood Association (see Highland Neighborhood Association endorses Guadalupe-Lamar for urban rail) and the Highland Neighborhood Planning Area defined by the City of Austin (COA). While the actual Highland neighborhood and planning district includes North Lamar Blvd. (mostly as its western boundary) all the way from Denson Drive to U.S. 183, ProCon’s “Highland” sector studiously avoids Lamar, and never reaches U.S. 183; instead, the sector incorporates I-35 (never even touched by the real Highland), and droops down far south of the actual neighborhood to include Hancock Center and the northern edge of the UT campus — thus overlapping the long-proposed Mueller route for urban rail. In this sense, “Highland” appears to be manipulated here as a kind of “proxy” for the COA’s original plan, functioning as a precursor of a full route to Mueller.

► Severed and segmented travel corridors

This was perhaps the single most serious fault of the Project Connect exercise — not only failing to examine actual corridor travel patterns, but essentially destroying intact corridors, such as Guadalupe-Lamar, simply because they crossed boundaries of the arbitrary sectors. As we first noted in Project Connect’s “corridor” study — without corridors!

Perhaps the most serious flaw in ProCon’s urban rail study methodology — actually, catastrophic, because it fundamentally impairs the integrity of the whole process — is that the actual travel corridors are not only basically ignored as workable corridors, but also are truncated and segmented by ProCon’s arbitrary slicing up of the urban area.

If you’re evaluating a travel corridor, you must evaluate the corridor as a whole — what it connects from, to, and in between; what the populations and densities along the corridor are; what activity centers it connects; and so on. All those are important, because they’re critical to what makes a transit line in that corridor actually feasible and worth investing in.

The results for the Guadalupe-Lamar travel corridor were basically fatal, as we pointed out:

the Guadalupe-Lamar route is severed just north of the UT-West Campus area at W. 29th St. In other words, most of this potential route is cut off from its highest-density population district as well as its most productive destinations in the core of the city!

What’s left is a “rump” route, from a few blocks south of U.S. 183 to W. 29th St., that seems to have little purpose beyond perhaps some kind of “shuttle” along this isolated route segment. If there were a prize for idiotic public transport planning, surely Project Connect would be very high on the candidate list.

This problem also was repeatedly underscored. In our article Memo to CCAG: “Pause” study or include “Lamar” sector (5 December 2013) we warned that “The basic methodology of focusing on sectors (so-called ‘sub-corridors’) meant that the study failed to study a single actual potential travel corridor in the study area”, and added:

This methodology also segmented an otherwise viable corridor such as Guadalupe-Lamar into nonsensical pieces, severing the corridor from its most logical destination (West Campus and core area), and thus creating an arbitrary “rump” route (29th St. to south of U.S. 183) that goes from nowhere to nowhere.

Likewise, in Project Connect Needs an Overhaul (7 December 2013), we reiterated: “Project Connect’s methodology segmented the outstanding Guadalupe-Lamar corridor into nonsensical pieces, severing it from its most logical destination (the West Campus and core area), thus creating an arbitrary ‘rump’ route that goes from nowhere to nowhere.” These warnings, of course, were ignored.

► Excluding student and other nonwork travel patterns

While specific travel corridor trips were not examined in the “study”, Project Connect did include tabulations of total travel in each sector and estimates of trips between sectors and the Core Area. However, a particularly breathtaking aspect of the project’s Evaluation Matrix (also called the Comparison Matrix) was the exclusion of all trips except home-based work trips. In other words, non-work trips — including student trips — were omitted from consideration.

As we asked in our “data dig” Questions for Project Connect, “Why has this study’s assessment of “travel demand” from each sector to the core ignored home-based non-work (HBNW) trips — including UT student trips and recreational trips — in a college city with the largest university in Texas in its core area?”

This omission was repeatedly emphasized in subsequent articles. In our Memo to CCAG: “Pause” study or include “Lamar” sector, we pointed out:

As a measure of “Travel Demand” from each sector to the core, non-work trips such as UT student trips and recreational trips (e.g., to restaurants, bars, etc.) have been EXCLUDED — dismissing not only the enormous importance of non-work trips (which are heavy in the off-peak) for more cost-effective transit service, but especially the huge significance of student and recreational trips in a city with the largest university in the state (and located in its core).


Student travel was omitted from Project Connect's evaluation process, although their ultimately recommended route connected UT, the state's largest university, with ACC, the city's major community college. Photo via UTRugby.com.

Student travel was omitted from Project Connect’s evaluation process, although their ultimately recommended route connected UT, the state’s largest university, with ACC, the city’s major community college. Photo via UTRugby.com.


And similarly, in Project Connect Needs an Overhaul, we asked:

Extremely important non-work trips such as UT student trips and recreational trips have been EXCLUDED as a measure of “Travel Demand” from each sector to the core. How could they do this in a city whose core contains the largest university in the state?

In hindsight, the omission of student travel from the Evaluation Matrix is especially ironic in light of the fact that travel between UT and ACC would ultimately be a major component of the purported ridership of the final route presented by Project Connect.

► Manipulation of implausible projections

Skepticism about Project Connect’s heavy reliance on dubious projections began to emerge as the pace quickened toward a “recommendation” from the project team. In our 3 December 2013 article related to the “data dig”, Questions for Project Connect, we asked: “Why has this study used such speculative projections based on procedures that maximize all possible development for targeted areas (such as ‘ERC’, ‘Mueller’, and ‘Highland’), rather than using conservative projections based on conditions closer to reality?”

Local researchers and analysts such as software developer and research analyst Dan Keshet and management consultant Julio Gonzalez Altamirano had exposed serious weaknesses in the array of data projections being deployed by the project team — especially the conversion of what were in effect development “wish lists” into hard projections of future development, population, and employment that were being plugged into Project Connect’s model (an Excel-based “Evaluation Matrix” designed to competitively score the various sectors and render a winner). Their conclusions and other problems of the project’s data projections are discussed in our article What’s with Project Connect’s “2.9 million daily ridership” projection? (16 December 2013). As this article noted,

The question of projections has been an extremely contentious issue in Project Connect’s urban rail “study”. For many critics, the agency’s “projections” have represented de facto fantasies about what they would like to see, rather than the solidly reliable output of competent predictive analytics.

While projections were critical in any process of forecasting future developments and especially public transit ridership, we explained, “…there’s a vast distinction between developing conservative, reliable, and plausible forecasts, and producing exaggerated, fantasy-like projections, as Project Connect has done, heavily skewed toward certain geographical areas.”


Many of Project Connect's "data projections" for 2030 were based on "wish lists" of development, population, employment, and other demographic features — leading critics to ridicule them as "fantasy". Graphic via ARN.

Many of Project Connect’s “data projections” for 2030 were based on “wish lists” of development, population, employment, and other demographic features — leading critics to ridicule them as “fantasy”. Graphic via ARN.


In the 17 November 2013 article Surprise! Mayor and Project Connect select same routes they wanted in the first place, we expressed skepticism about “the selection of a predominantly questionable array of data elements as the basis for ‘evaluation’ of the various sectors. Leaving their ‘weighting’ aside, in the aggregate the evaluatory elements themselves are inappropriate.”

As the article explained,

ProCon relies very heavily on projections of future conditions for their basic measures. As the rail advocacy group AURA (Austinites for Urban Rail Action) has explained in its evaluation guide, projections themselves are basically unreliable, risky, flaky, whereas, in contrast, “We believe use of the real-world, recently-observed data gives the more accurate and reliable picture of potential ridership, as well as the greatest viability for federal funding.”

… Beyond a roughly five-year horizon, projections for specific neighborhoods and similar chunks of real estate basically become unreliably speculative — which seems to be what we’ve actually been dealing with … a significant dollop of real estate speculation, given a kind of veneer of “techiness” by CAMPO and their land use/travel demand model package.

For decades, public transportation advocates have warned repeatedly about the “self-fulfilling prophecy” syndrome in this kind of transportation planning process. In the past, it’s been applied mainly to highway development — justifying “future growth” in just the right places where developers want to build, so as to rationalize huge investments in new freeways and other roads. And, lo and behold, these very projections somehow materialize after the transportation facilities are built, thus “proving” the “validity” of the projections!

Today, in Austin, this process may be at work justifying speculative land development in certain areas of the central city (i.e., the central study area — “Central Corridor”), this time with the added drawback of ignoring or dismissing opportunities for redevelopment of areas in the heart of the core city, particularly centered along the Guadalupe-Lamar corridor.

As an example, in our article “Highland” sector favored by Project Connect — but where’s the travel demand? (19 November 2013) we noted that Project Connect’s presentation of CAMPO travel demand data in their own Map Book contradicted the claims of high travel demand in the “Highland” sector — one of the key underpinnings for their “recommendation” of a route to serve this fabricated sector. Thus, we warned, “since Project Connect based its assessment significantly on this data, the results presented, and the contrary evidence of very strong travel demand in the Guadalupe-Lamar corridor, contradicting Project Connect’s own stated conclusions, should at the very least raise questions about the competency and integrity of the study process.”

As we summarized the pattern in What’s with Project Connect’s “2.9 million daily ridership” projection?

Another way of saying this is that Project Connect’s planners have converted their own wishful thinking into actual data inputs, that are then deployed to make their evaluation. Wishes are used to try to make the wishes come true.

► Applying subjectively derived scores

Despite the characterization by supporters that Project Connect’s efforts were thoroughly “data-driven” and “scientific”, some components of their “study” were not even camouflaged as “projections” or externally derived data, but instead were presented merely as subjective judgements of the project team. In our 3 December 2013 “data dig” Questions for Project Connect, we asked

Project Connect’s “Physical Constraints” metric appears to be based on totally subjective value assessments, and no information has been given as to how these value judgements have been developed. Where’s the factual basis for this?

The response was that these scores were based purely on the team’s “professional judgement”. We highlighted this on our article Memo to CCAG: “Pause” study or include “Lamar” sector:

The study has assigned an extremely high “Constrained Right-of-Way” penalty to the “Lamar” sector, but not to the “Highland”, “Mueller”, “ERC” sectors — apparently implying that Project Connect considers there to be no “Constrained Right-of-Way” problems for “Highland”, “Mueller”, and “ERC”. This also is implausible, and this penalty seems to be arbitrarily applied to sectors (“sub-corridors”) that the Project Connect team dislikes (e.g., “Lamar”), but withheld from sectors they seem to prefer (e.g., “ERC”, “Highland”, “Mueller”).

► Selective manipulation of data

Another practice skewing Project Connect’s “study” results was their “cherry-picking” of data categories and their selective manipulation of their own methodology — pre-eminently, the Transit Orientation Index model they appropriated from Portland. As we explained in our analysis What’s with Project Connect’s “2.9 million daily ridership” projection? (16 December 2013):

Apparently in an attempt at a gesture toward some kind of prediction of future transit ridership, one of the metrics Project Connect decided to use in their Comparison Matrix is a “Transit Orientation Index” (TOI), a ridership demand assessment model developed in 1997 by consultants for Portland, Oregon’s TriMet transit agency. …

According to the documentation, the TOI metric is envisioned to assess transit ridership demand at the level of a small analysis zone …. Project Connect planners, however, have applied the model to considerably larger sectors covering several square miles with hundreds and even thousands of acres.

We’d previously summarized the astounding problem with the TOI model in our Memo to CCAG: “Pause” study or include “Lamar” sector, which warned that, when key projections, already embedded in the Evaluation Matrix, were plugged into the TOI,

… the results are extremely implausible — e.g., for the “ERC” (East Riverside) sector, Project Connect calculates high total daily transit ridership of 2.9 million, about equal to the total citywide daily ridership of Chicago and Philadelphia combined. (Their “low estimate” for that single sector is higher than the total citywide ridership of entire cities like Denver and Seattle.) This strongly tends to corroborate other evidence that Project Connect’s projections have been seriously exaggerated and are utterly implausible.

Likewise, in Project Connect Needs an Overhaul we observed:

Rather than developing conservative, reliable, and plausible forecasts, Project Connect has produced exaggerated, highly questionable projections, heavily skewed toward certain geographical areas. When these same projections are plugged into Project Connect’s own Transit Orientation Index (TOI), the results are ridiculously unbelievable. For the single “ERC” sector, the low-end prediction of daily transit ridership is higher than the total system daily ridership of entire cities like Denver and Seattle. On the high end, it’s about equal to the total system daily ridership of Chicago and Philadelphia combined.

These implausible outputs from the TOI were jaw-dropping. When the projections of Year-2030 population, employment, and other data items that were mainstays of their Evaluation Matrix were fed into the model, even the low-end results were absurd. For the “ERC” (East Riverside) sector, for example, as we pointed out in our What’s with Project Connect’s “2.9 million daily ridership” projection? analysis, “… the low-end figure — daily ridership of 492,682 (493K) — is equally preposterous, exceeding the total system daily ridership of entire large cities.” These cities included Portland, Seattle, Denver, and Atlanta.

As for the Highland sector, TOI results were likewise other-worldly. As we noted,

…the TOI model results for 2030 are similarly off the scale. Whereas current 2013 ridership is about 5K (5100/day), the “low” TOI prediction for 2030 is about 127K — an increase of 2,440%. The “high” prediction (no need for upper-bound substitution in this case) is 279K — a predicted increase of 5,480%.

Put another way, to meet the lower-end ridership suggested by the demographic and economic projections, average daily ridership in the “Highland” sector would have to exhibit sustained average daily ridership growth of about 7,200 each year for 17 years.

Curiously, while the project team excluded such embarrassing outputs from the TOI model from their matrix, they were selectively using other aspects of the TOI as inputs for the same matrix. As we noted,

… Project Connect’s matrix does use the TOI, itself based on the same dubious projection inputs, to render a metric score to bolster their preferred sectors (“sub-corridors”) in the competition they’ve set up. …

But, even more importantly, the TOI for 2030, dependent as it is upon Project Connect’s “projections” (de facto fantasies), exposes their absurdity. No wonder Project Connect and its entourage don’t want these used … no wonder they attempt to distance themselves from them!

It’s very simple — plug Project Connect’s own projections into this otherwise fairly realistic model, and you get bizarrely, unbelievably exaggerated results. Maybe a hint that the original projections are bizarrely unbelievable?

In effect, the TOI is performing here somewhat like a “canary in the coalmine” — telling Project Connect, and all of us, that something is terribly wrong with their demographic and economic projections for 2030.

Big Picture: Fraud

The impact of all these seemingly disconnected errors, missteps, omissions, and methodological shenanigans on a single portion of the “study” area is illustrated by the infographic at the top of this post, which focuses on several of the sectors surrounding the Guadalupe-Lamar travel corridor. (The so-called “Lamar” sector was widely misinterpreted as this corridor itself, but it was actually just a wide swath of urban real estate, stretching as far west as Shoal Creek Blvd., and embracing Burnet Road to the west as well as a segment of Guadalupe-Lamar in its eastern half — and neither of these two major travel corridors was examined.) As this graphic makes clear, the ground rules and methodology of Project Connect’s “study” very effectively prevented meaningful evaluation of this key, heavily traveled, central corridor.

From this grab-bag of colossal problems, your first assessment might be that Project Connect’s team was the rail planning equivalent of The Gang That Couldn’t Shoot Straight. Unfortunately, it’s worse. What actually emerges out of all this, from the vantage point of a year of hindsight, is a much more troubling image than mere ineptitude — by connecting the dots, the outline of a deliberate effort to deceive and to manipulate the “study” becomes unmistakable.


Kyle Keahey promoting "high-capacity transit" route selected by Project Connect, Nov. 2013. Photo: YouTube screengrab.

Project Connect Urban Rail Lead Kyle Keahey presenting “recommendation” of Highland-Riverside urban rail route, Nov. 2013. Photo: YouTube screengrab.


Contradictory as it might seem, it’s entirely plausible that otherwise technically competent members of the Project Connect team, drawn into the “trees” of the exercise, were unaware of the implications of the larger “forest”. Also the mind, with its ability to rationalize, justify, and alibi, can be a very mysterious apparatus.

In any case, the motives for tailoring the proposed urban rail route to the needs of development policies and interests are also very clear. These are described particularly in three of our articles:

Who are those guys? Real estate development interests and Austin’s urban rail boondoggle

UT should pay for East Campus urban rail — not Austin taxpayers

Derailing the Mueller urban rail express — Preamble to Project Connect’s 2013 “High-Capacity Transit Study”

So there’s motivation. There’s an amazing assortment of jaw-dropping methodological botch-ups. And it all fits together to promote the desires of the sponsors of the exercise.

The Big Picture we see of this whole process is dominated by a bright red fluorescent flashing sign. The sign says: Fraud. This is definitely a model of rail planning for other communities — a model to avoid at all costs. ■

h1

Derailing the Mueller urban rail express — Preamble to Project Connect’s 2013 “High-Capacity Transit Study”

2 November 2014
Urban rail concept started as a plan for a streetcar "circulator" system, shown in this early map from 2006. Map adapted from Austin Chronicle.

Urban rail concept started as a plan for a streetcar “circulator” system, shown in this early map from 2006. Map adapted from Austin Chronicle.

To understand the roots of the Highland-Riverside urban rail plan on the ballot today, you need to understand how an official “express train” planning process, aiming to lock in an urban rail line to the Mueller redevelopment site, got derailed and sidetracked by community intervention. Here’s a very abbreviated version of the story.

Austin’s current “urban rail” planning arose ca. 2005-2006 following the November 2004 voter approval of Capital Metro’s “urban commuter rail” project, in a package (including “rapid bus” service) called All Systems Go proposing the operation of DMU (diesel multiple-unit) railcars between downtown and the suburb of Leander. The previous light rail (i.e., urban rail) plan for a line on Guadalupe, North Lamar, and the railway alignment northwest as far as McNeil had been shelved in mid-2003 in favor of the cheaper, but very bare-bones, DMU plan.

Since the newly approved DMU line ran on a railway alignment that bypassed most of the heart of the city, ending only at the southeast corner of the CBD, officials and planners realized they needed some way to connect passengers with key activity points, including UT and the Capitol Complex. The answer they devised was a “circulator” system using streetcar technology, which would intersect with the DMU line (eventually rebranded as MetroRail) and connect to downtown Austin, the east side of the Capitol Complex, the East Campus of UT, and the Mueller development site. (See map at top of post.)

But, critics asked, what about the dense West Campus neighborhood and the busy commercial district on The Drag? What about the original plan for light rail along Guadalupe and Lamar? The “rapid bus” service included in the All Systems Go package, intended as a precursor to rail in the Guadalupe-Lamar corridor, was then viewed only as a temporary “fix”, and it seemed clear that rail needed to be planned for that corridor as well.

Within Capital Metro, Lyndon Henry (then a Data Analyst with the transit agency) pressed the case for at least an initial rail line to serve The Drag and West Campus, and at public meetings on the proposed “circulator” Henry and others continued to raise the issue. In this period, as problems emerged with the MetroRail project, Capital Metro’s involvement in the streetcar project was superseded by the City, which assumed control. When Henry’s supervisor Matt Curtis left Metro to become an aide to Mayor Lee Leffingwell, for a brief period a West Campus spur did appear in City of Austin planning maps for the proposed streetcar. (Henry is currently a contributing editor to this website.)

In 2008, as a line on East Riverside to ABIA, with a bridge over the river into the CBD, was proposed, planners became convinced that capacity and speed required fullsize light rail transit (LRT) rolling stock. However, apparently to distinguish the emerging plan from the original, centrally routed Guadalupe-Lamar line, and to retain some of the supposed lower-cost ambience of streetcar technology, the expanded system was dubbed “urban rail”, supposedly a hybrid between a streetcar and a rapid LRT system. By 2010, the Central Austin Transit Study (CATS), prepared by a consortium headed by URS Corporation, recommended a system that stretched from the Mueller site, down Manor Rd. and Dean Keeton to San Jacinto, then south through the East Campus, across the river, and out East Riverside to ABIA. Alternative alignments were suggested, and spurs to Seaholm and the Palmer Auditorium area were also proposed as later extensions.

As the project made its way through the National Environmental Protection Act (NEPA) process, and afterward, the route structure gradually solidified; for a connection to Mueller, a preference was emerging to move the alignment from Manor Rd. to a route via Red River and Airport Blvd. But even the gesture of a spur connection to the West Campus began to vanish, prompting Lyndon Henry and the Light Rail Now Project to call attention to the need for urban rail in the “Missing Link” — the gap between MetroRail’s station at Crestview and North Lamar, and its terminus downtown. Because of that gap, not only were passengers inconvenienced by having to transfer to buses to access their destinations along the Guadalupe-Lamar corridor, but also Capital Metro was running costly bus shuttles to connect MetroRail stations on the east side to the UT campus and the Capitol Complex. See: Give priority to “Missing Link”.


MetroRail Red Line (red) skirts entire heart of central Austin, illustrated by "Missing Link" through Guadalupe-Lamar corridor. Urban rail would provide the crucial connections to core neighborhoods, UT West Campus, and Capitol Complex missed by MetroRail. Infographic Map by Light Rail Now.

“Missing Link” urban rail (green), in Guadalupe-Lamar corridor, would provide the crucial connections to core neighborhoods, UT West Campus, and Capitol Complex missed by MetroRail (dashed red line). Infographic Map by Light Rail Now.


But why had the West Campus, and Guadalupe-Lamar, disappeared from the official urban rail plan? As Henry, Dave Dobbs, Andrew Clements, Roger Baker, and others persistently raised this issue, mainly at meetings of the Transit Working Group (a blue-ribbon committee of civil leaders nominally attached to CAMPO, the Capital Area Metropolitan Planning Organization), planners and officials under the aegis of the Project Connect public agency consortium pointed to a Route Alternatives Evaluation Process included in the 2010 CATS project that had supposedly ruled out a “University of Texas (UT) to North Central Austin (Hyde Park)” route, instead giving top scores to routes serving Mueller, East Riverside, and Seaholm — basically, what City policy actually wanted.

Scrutinizing the “Route Alternatives Evaluation”, Henry identified serious methodological drawbacks and summarized these in a commentary, City’s Urban Rail “alternatives analysis” omitted crucial Lamar-Guadalupe corridor! presented to the TWG on 27 April 2012. These problems are also discussed in our article City’s 2010 urban rail study actually examined corridors! But botched the analysis… (26 November 2013). Basically, the 2010 “evaluation” totally ignored the Guadalupe-Lamar corridor, and “evaluated” an array of alternatives with subjective ratings of 1, 2, or 3. Thus, voila! The preferred official routes, including the route to Mueller, won the “competition”!


CATS map of actual potential rail corridors studied. Map: COA and URS.

CATS map of potential rail corridors studied — but Guadalupe-Lamar was omitted! And subjective scoring system facilitated ratings that favored City’s desired route plan. Map: COA and URS.


In what seemed like an Urban Rail Express to Mueller, by May 2012, the official urban rail proposal had gelled into a Phase 1 project running 5.5 miles from downtown, through UT’s East Campus via San Jacinto, then northeast via Red River St., 41st St., and Airport Blvd. into the Mueller site. The total investment cost was estimated to be $550 million.


Finalized in May 2012, 5.5-mile, $550-million Phase 1 urban rail starter line was proposed to connect downtown, UT East Campus, Hancock Center, and Mueller site. Graphic: Project Connect.

Finalized in May 2012, 5.5-mile, $550-million Phase 1 urban rail starter line was proposed to connect downtown, UT East Campus, Hancock Center, and Mueller site. Graphic: Project Connect.


But the constant pounding by community critics — especially Lyndon Henry’s exposé of the outrageously dubious Route Alternatives Evaluation from 2010 — was taking its toll. The result was that Project Connect placed the Mueller Phase 1 plan on hold and shifted course dramatically. In early 2013, Kyle Keahey was hired as Urban Rail Lead to head a new “High-Capacity Transit Study”, tasked with supposedly re-evaluating everything, racing through a process (with a presumably more competent and defensible methodology) that would result in a recommendation by the end of 2013.

To some, it seemed a new beginning and a possibly more hopeful and fair approach to analyzing travel corridors, particularly the heavily traveled, high-density, and widely popular Guadalupe-Lamar corridor. Unfortunately, that was not to happen. As it proceeded, it became increasingly clear that the much-vaunted “High-Capacity Transit Study” was actually a fraud. The highlights of this process will be summarized in a subsequent report. ■
