Archive for the ‘Capital Metro policy and planning’ Category

h1

Capital Metro strikes three blows against Lamar-Guadalupe light rail

31 May 2018

Graphic: Grace in the city

In a post this past February 28th, we reported on a surprising development coming from Capital Metro’s Project Connect planning process – the “conceptual” proposal of a 21-mile predominantly linear north-south light rail transit (LRT) corridor, running from Tech Ridge in North Austin, through the central heart of the city, to Slaughter Lane, near the Southpark Meadows area, in South Austin. The proposal particularly extolled the merits of a 12-mile-long segment, through the Lamar-Guadalupe corridor, from Tech Ridge to downtown.

After over four decades of indecision, missteps, and delay, it seemed like the transit agency (and city leadership) might, amazingly, have turned a corner. Could this actually mean that, at long last, Capital Metro and Austin’s top leadership were prepared to move ahead with a plausible, workable light rail plan – implementing a long-awaited leap forward in urban mobility – for the city’s most important central corridor?

Unfortunately, no. Slightly over a month later, Capital Metro reversed itself, withdrew the LRT proposal, and reverted to the familiar decades-long pattern of indecision, confusion, dithering, and delay that has gripped Austin like a curse.

Instead of an actual, specific project for a new light rail system, with a starter line from Tech Ridge to Republic Square downtown, the proposal had dissolved into the clouds, becoming just another line on a map of “perhaps something, some day”. To explain the retreat, planning was now described as “mode agnostic” – in other words, reverting back to a kind of official daydreaming, without any modes (the things that people would actually ride) identified to define a real-world project.

Almost exactly a month later, Capital Metro’s board made another fateful decision. Whereas mode-specific recommendations from the Project Connect study were scheduled for June, the board delayed that back to late in the fall (or perhaps winter) – far too late to put any kind of actual, mode-specific project (such as the previous LRT proposal) on the November ballot for possible voter approval of bond funding. (At best, this would now delay voter approval of any hypothetical project until the 2020 election cycle.)

A third blow against LRT in the Lamar-Guadalupe corridor was struck on May 8th, when the Capital Area Mobility Planning Organization (CAMPO) approved a Capital Metro-sponsored plan (originally submitted Jan. 19th) to overhaul the N. Lamar Blvd.-Airport Blvd.-MetroRail intersection (adjacent to the Crestview MetroRail station) with a design – exclusively focused on accommodating and facilitating motor vehicle traffic, rather than public transport – that would impose enormous obstacles to LRT on North Lamar. Currently, community activists and urban rail advocates are endeavoring to prompt a redesign of this project.

For decade after decade, the Austin community has agonized, writhed, and wailed over its steadily mounting mobility crisis. Hundreds of miles of lanes and roads have been built and rebuilt, and even more vigorous roadbuilding is currently underway. Yet the mobility crisis continues to worsen – for many motorists, driving around the urban area increasingly feels like trying to swim through solidifying mud. Or, alternatively, slogging through a battlefield ….

Repeatedly, the need for light rail has been affirmed. (See «Long saga of Guadalupe-Lamar light rail planning told in maps».) As we pointed out in a March 2015 post, “For two and a half decades, local officials and planners have explained why urban rail — affordable light rail transit (LRT), in Austin’s case — has been an absolutely essential component of the metro area’s mobility future.” («Austin’s urban transport planning seems struck by catastrophic case of amnesia and confusion».)

Capital Metro designated LRT in the Lamar-Guadalupe corridor as the region’s Locally Preferred Alternative in 1989. In 2000, Capital Metro hastily placed LRT on the ballot – but, in a poorly organized election campaign, it was defeated in the overall service area by a tiny margin (although it was approved by Austin voters). In 2014, another LRT plan was presented to Austin voters under the slogan “Rail or Fail” – but, proposed for the ridiculously weak Highland-Riverside corridor, the plan was resoundingly rejected. (See «Austin: Flawed urban rail plan defeated — Campaign for Guadalupe-Lamar light rail moves ahead».)

Time and time again, Austin has demonstrated that it’s the national poster child for chronically muddled urban mobility planning. In a January 2015 post, we warned that “Austin – supposedly the most ‘progressive’ city in the ‘reddest’ rightwing state of Texas – has a distinctive (read: notorious) reputation for dithering, dallying, and derailing in its public transport planning ….” («Strong community support for Guadalupe-Lamar light rail continues — but officials seem oblivious».) As our previously-cited March 2015 post went on to observe: “The devastating befuddlement of Austin’s official-level urban transportation planning … has been nothing short of jaw-dropping.”

Will Austin, and Capital Metro, ever manage to break out of this pattern of failure? Does hope still spring eternal?

h1

How Capital Metro’s planning keeps falling short

31 December 2017

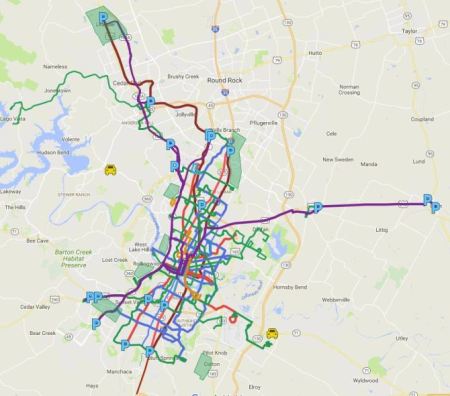

Capital Metro’s proposed Connections 2025 map. Graphic: CMTA.

Commentary by Roger Baker

Roger Baker is a longtime Austin transportation, energy, and urban issues researcher and community activist. The following commentary has been adapted and slightly edited from his comments recently posted by E-mail to multiple recipients.

Capital Metro says it has a major renovation in its bus network underway. Perhaps, but in my opinion, Cap Metro is trying to do too much on too little money. In addition, the agency is politically manipulated, held on a tight city leash by long tradition, with top-down political forces in charge.

Being a big institutional cookie jar has become a practical barrier to developing really smart, compassionate policy, one that riders can depend on from year to year. For example, good Cap Metro planners should understand and hedge against the fact that Cap Metro sales tax revenues can fall as well as rise, depending on the quirky volatility of Austin’s tech-based economy.

This latest transit policy is the result of being forced to choose between two groups and types of service: trying to accommodate the scattered captive riders on the cheaper living-cost fringes, versus the more time-sensitive discretionary riders near the core.

One of the kinder, more compassionate resolutions of this dilemma would be a compromise. The most needy or most bus dependent nearby areas would have bus service that at least wouldn’t get any worse for the next five years, come hell or high water. That way it would be possible for these folks to often hold service jobs in Austin, and the transit service could motivate people who struggle to meet tight family budgets to migrate to these same transit-friendlier areas. At the same time, in the spirit of compromise, Cap Metro could offer a few less 15-minute bus routes serving the core area, but this promise of improved, higher-frequency core service would be equally firm.

But here’s another problem with that. Cap Metro suffers from an acute lack of transit planning that can stay on track for a time that exceeds the current management’s longevity and influence.

Overall, the core problem facing Austin transportation is getting from cheap suburban living to living-wage jobs via existing highways like I-35. Roads like this will never be able to affordably handle this level of peak mobility demand. We should learn to regard congestion as self-limiting in nature.

Insofar as this daily peak traffic is partly related to core retail commerce, will these jobs still be there in predicted numbers, after another five years of Amazon killing local retail? How did the planners at Cap Metro get in such trouble with their sales tax projections? Has that budgetary over-optimism been fixed?

In my opinion, focusing on short-term planning and compassionate meeting of current transit needs in the next few years should get top priority. Included in this category is a $400 million light rail starter line segment down the Lamar-Guadalupe corridor, which is clearly needed today to unclog that corridor.

h1

Why “Super BRT” in I-35 would betray Capital Metro’s member cities

31 October 2017

Project Connect rendition illustrates how “SuperBRT” might use high-occupancy toll (HOT) lanes alongside a highway such as I-35. But where are the stations? Graphic: CMTA online.

Commentary by Dave Dobbs

Dave Dobbs is publisher of LightRailNow.com. This commentary has been adapted and expanded from original private Email comments.

This website’s recent articles «Officials boost roads and “Super BRT”, put urban rail on side track» (Aug. 31) and «Why TxDOT-Capital Metro ‘BRT’ plan for I-35 is a massive boondoggle» (Oct. 1) explained how (under pressure from TxDOT) Capital Metro has been proposing to designate I-35 as Austin’s primary transit corridor, and to install a 21-mile express bus facility (“Super BRT”) in what is to be an overhauled freeway-tollway. “Politically aware” members of Capital Metro’s board ought to understand that providing scarce Capital Metro dollars for this “Super BRT” project – designed mainly to serve non-member cities like Round Rock (voted not to join the transit agency in 1985) and Pflugerville (withdrew in 2000) – is a betrayal of the original sales-tax-paying members of Leander, Jonestown, Lago Vista, Point Venture, Anderson Mill, Volente, San Leanna and Manor, all of which (except Manor and San Leanna) are located northwest, on the US 183 corridor.

Most importantly, with over 95% of Capital Metro’s local tax revenues coming from Austin sale taxes, I-35 Super BRT is a very poor use of limited resources from the benefit principle perspective. This is bad public policy and bad public finance with a negative ROI.

Capital Metro board members, other local officials, Austin’s civic leadership, and the metro area public at large need to consider: What does expending scarce transit agency funds on “Super BRT” to run in I-35 – i.e., funding a transit facility that primarily benefits non-member citizens – say to Capital Metro’s taxpayers?

In contrast, a Guadalupe-Lamar corridor light rail connection to MetroRail at Crestview would be highly advantageous to those who pay the Capital Metropolitan Transportation Authority (CMTA) 1¢ sales tax. In lieu of this, where’s the benefit to the citizens of Austin and six of the eight member cities who’ve the sales taxes for CMTA transit service from the start?

This is a serious public finance question. Jonestown, Lago Vista, Leander, Point Venture, Volente, Anderson Mill and vast areas in Austin’s northwest ETJ are entitled to any major transit fixed quideway investment on a first-priority basis over entities who never were or aren’t now Capital Metro members. Spending Capital Metro money on an IH35 “busway” is a complete rejection of the Benefit Principle.

h1

Transit planning cabal-style

28 February 2017
Graphic: Marvel Database.

Graphic: Marvel Database.

In recent weeks, within Austin’s transit advocacy community, rumors have been circulating of some kind of “package” of major transit projects possibly being compiled, perhaps for the November 2018 election cycle. While details are murky – concocted behind the veil of a resuscitated Project Connect and the tightly shuttered enclaves of the high-level leadership consortium of Capital Metro, City of Austin, plus some Travis County and state officials – it is whispered that such a plan might include a “Guadalupe-Lamar project” as well as an expansion of the MetroRail regional railway, a highway-routed bus “rapid transit” (BRT) line, and other possible projects.

A “Guadalupe-Lamar project” sounds great – a starter light rail transit (LRT) line in the Guadalupe-Lamar (G-L) corridor would represent the crucial linchpin of an eventual LRT (urban rail) network for the entire metro area. But there’s no guarantee that LRT is the “project” behind the dark curtain. Whatever concrete details of these wisps of plans may exist seem to be closely guarded secrets. For the G-L corridor, officials, planners, and their consultants may be envisioning urban rail, or they might just as plausibly be concocting more investment in the pathetic MetroRapid faux-“BRT” operation … or a cable-gondola line … or some other scheme.

The problem is that this top-level methodology of secrecy is now the routine modus operandi of most of Austin’s major public transport planning. And this, in an era of so-called “transparency”.

In fact, a lot of this methodology comes close to the definition of a cabal: “the contrived schemes of a group of persons secretly united in a plot ….” While it doesn’t have the cohesiveness of a bona fide cabal – and it certainly isn’t motivated by evil intent – today’s transport planning process nevertheless feels enough like a behind-the-scenes cabal to merit this unfortunate comparison. (And that’s why we’ve dubbed it “cabal-style”.)

Local planning wasn’t always this Machiavellian. Back in the early days of the Austin Transportation Study (predecessor of CAMPO) and Capital Metro, particularly in the 1970s and 1980s, planning was upfront; plans were on the table for public review, discussion, and debate. Community activists were intimately involved in the planning process; public participation was vigorous and vibrant. Meetings of advisory bodies such as Capital Metro’s Citizens Advisory Committee and Transitway Corridor Analysis Project Advisory Committee were frequent and well-attended, often by participants in the dozens. Plan proposals were not only clearly on view, but were shaped and fine-tuned by direct community input.

That process has, in recent years, been squelched. Interactive public meetings have been replaced by “open houses” and “workshops” where actual full discussion among all participants is excluded. Austin Rail Now has analyzed and criticized this deleterious process in considerable detail – see the numerous articles collected in the category Public involvement process.

Bona fide, free-speaking, freely attended, full public meetings are a critical component of democratic process. That’s how ideas are raised, shaped, tweaked, finalized – via discussion within groups of participants with a diversity of expertise, backgrounds, viewpoints, insights.

You can be sure that these occult, mysterious transit plans we’ve been referring to have been hatched by vigorous interactive meetings … not of the public, but of a relatively tiny, cabal-like huddle of officials, planners, and consultants sheltered from public view and involvement. A carefully assembled community body like the Multimodal Community Advisory Committee is allowed an occasional glimpse of what’s already been decided elsewhere … and then, only every few months or so. Back in the days of the directly involved and intensely active public advisory committees, meetings were held several times a month (especially in the final stages of formulating plans).

Even through this dark, distorted process, perhaps acceptable plans will emerge that will be embraced by the Austin community. But don’t hold your breath. The absence of direct, intimate, ongoing, adequately engaged, fully democratic public participation seriously increases the risk of flawed outcomes and political problems.

h1

Capital Metro: Let’s have 2 1/2 more years of analysis paralysis

27 February 2016

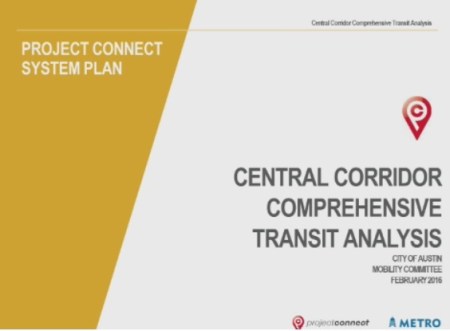

Title slide of Capital Metro's CCCTA presentation to Austin City Council Mobility Committee on Feb. 3rd. Screen capture: ARN.

Title slide of Capital Metro’s CCCTA presentation to Austin City Council Mobility Committee on Feb. 3rd. Screen capture: ARN.

After months of preparation, organizing, bidding, and selection, with lots of fanfare Capital Metro at last launched its $3 million, 30-month (2.5-years) Central Corridor Comprehensive Transit Analysis (CCCTA) study. In a Jan. 25th news release, Capital Metro announced that its board of directors had selected engineering firm AECOM as the lead consultant to conduct the Central Corridor analysis.

To the uninitiated, inexperienced, and uninformed, this latest study might seem some kind of step forward for Austin’s transit development. After all, its elements include impressive-sounding goals like “An in-depth study of a variety of transportation modes and their potential for creating improved transit options within the corridor”, “A multimodal transportation plan that improves the feasibility of transit in the Central Corridor while effectively maximizing connections with regional routes in surrounding communities”, and “A realistic cost analysis for building, operating and maintaining the proposed sustainable and connected transit system”.


Capital Metro's planning chief Todd Hemingson explains CCCTA study to Austin Mobility Committee on Feb. 3rd. Photo: ARN screenshot from official video.

Capital Metro’s planning chief Todd Hemingson explains CCCTA study to Austin City Council Mobility Committee on Feb. 3rd. Photo: ARN screenshot from official video.


Analysis Paralysis gold medal

But, among grassroots public transportation advocates in Austin, it’s hard to find a transit supporter who’s enthusiastic about this study. The reason: All of these issues have already been exhaustively studied, and plans prepared and re-prepared, over and over and over and over again, for more than two decades. For Austin transit supporters, we’ve “been there, done that” — multiple times. It’s just one more repetitive “re-study of the re-studies of the re-studies ….”

To get a breathtaking idea of the time, resources, energy, and money Austin has sunk into planning for “high-capacity” public transport, just check out our February 2015 chronicle of studies and re-studies of light rail transit (LRT) in the Guadalupe-Lamar corridor: «Long saga of Guadalupe-Lamar light rail planning told in maps». This central travel corridor’s high level of traffic, population and employment density, and crucial position accessing and connecting vital activity centers (like UT, the Capitol Complex, and downtown) with key established neighborhoods and extended commercial activity along the route have made it the focus of planning for rail transit for over three decades.

In terms of public transit, Austin clearly is a top contender for the Analysis Paralysis gold medal. And Capital Metro’s latest CCCTA study, as it’s currently designed, surely represents Exhibit A toward this dubious award. The confusion, misdirection, conflicting intentions, and lack of purpose underlying this “paralysis” were discussed in our March 2015 article «Austin’s urban transport planning seems struck by catastrophic case of amnesia and confusion».

Meanwhile, as meaningful public transport planning continues to languish, the Austin metro area is experiencing a veritable blitz of intensive highway development and construction, including at least three new tollways, massive projects on I-35, and assorted projects throughout the urban area. As the saying goes, “Roads get built, transit gets studied“.

Project Connect back from the dead?

But confusion and a continuation of “analysis paralysis” aren’t the only problems with the CCCTA study. As currently configured, the study seems little more than a rehash of Project Connect’s ill-fated “High-Capacity Transit Study” which elicited such intense community outrage beginning in 2013, the precursor to its ultimate resounding rejection by voters in November 2014. Indeed, the CCCTA project seems the first major effort to resuscitate Project Connect since its 2014 debacle.

Among the worst weaknesses of the Project Connect disinterment is the revival of the seriously flawed methodology of the earlier “analysis”. This includes ignoring actual, existing travel corridors — such as the pre-eminent Guadalupe-Lamar corridor — and instead mislabeling huge chunks and sectors of the city as “corridors”. (The methodology further subdivided the “Central Corridor” into “subcorridor” mini-sectors.) Thus, according to Capital Metro, per the CCCTA study, “The Central Corridor is defined as an area bordered on the south by Ben White (US-290), on the east by the Capital Metro’s Red Line, on the north by RM 2222/Koenig Lane, and on the west by MoPac Expressway, and includes downtown Austin.”

Not only is that vast glob of central Austin not a corridor, but (as in the 2013 activity) this approach slices and truncates actual travel corridors, particularly Guadalupe-Lamar, rather than analyzing them in terms of their suitability and potential for actually solving mobility problems with public transport (particularly urban rail). We analyzed the problems with this in our November 2013 article «Project Connect’s “corridor” study — without corridors!»


Infographic shows how Project Connect’s methodology segmented Guadalupe-Corridor into nonsensical pieces, and summarizes numerous other major problems. (Click to enlarge.)

Methodology of Project Connect study in 2013 labeled huge chunk of central city as a “corridor”, but severed actual intact travel corridors into meaningless pieces. Graphic: ARN. (Click to enlarge.)


Community skepticism about Capital Metro’s “corridor” methodology in the CCCTA study was illustrated as early as last September by Jace Deloney, a co-founder of the influential AURA group (involved with urban and transportation issues) and former chairman of the City’s Urban Transportation Commission and Capital Metro’s Customer Satisfaction Advisory Committee:

It’s very important that we advocate against using the previous subcorridor definitions for any future high capacity transit planning project. In my opinion, these subcorridor definitions were deliberately designed to end up with a Red River alignment recommendation.

Re-direct the CCCTA study!

Besides the exhaustive “saga” of studies of the Guadalupe-Lamar corridor detailed in the ARN article cited and linked above, Austin Rail Now and other community stakeholders have presented LRT alternative alignment and design proposals that provide more than enough basis for quickly reaching a decision for an urban rail starter line. The most recent proposals are described in several ARN articles:

Plan for galvanizing Austin’s public transport development: Light rail starter line in Guadalupe-Lamar (June 2015)

Another major Austin community recommendation for light rail transit in Guadalupe-Lamar (November 2015)

Another possible design for light rail in Guadalupe-Lamar corridor (January 2016)

So far, in the absence of any sense of direction toward a major urban rail investment, Austin’s top political and civic leadership is vulnerable to pressure by highway interests (such as TxDOT) for municipal general obligation bond funding for a heavy local investment in a massive I-35 overhaul and other huge highway projects. To this, a major rail transit starter line investment might be counter-proposed as a far more effective and desirable alternative for city bond funding.

It would definitely seem time to end Austin’s decades of “analysis paralysis” and move forward quickly toward finalizing an urban rail plan for public approval — a strategy that could be expedited by re-directing Capital Metro’s CCCTA study. There is certainly sufficient planning and design preparatory work already in place to provide the voting public a basis on which to make a decision for the Guadalupe-Lamar corridor. The AECOM consultant team (widely respected in the public transportation industry, with experience with LRT in Portland, Minneapolis, and elsewhere) could simply update and tweak the major engineering studies that have already been done (e.g., those in 1993 and 2000) for the Guadalupe-Lamar corridor.

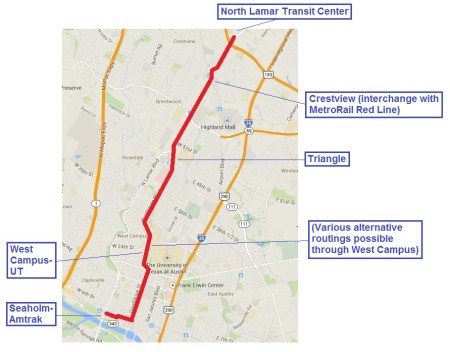

Proposed 6.8-mile "Plan B" light rail transit line in Guadalupe-Lamar corridor would have 17 stations and connect  the North Lamar Transit Center at U.S> 183 with Crestview, the Triangle, UT and the West Campus, the Capitol Complex, the CBD, and the Seaholm-Amtrak area. It's projected to serve 3 times the ridership of the Prop. 1 Highland-Riverside rail line at slightly over half the capital cost.

Austin Rail Now proposal is one of several possible configurations already suggested for light rail starter line in Guadalupe-Lamar corridor. Graphic: ARN.


This would likely require a major intervention by Austin City Council members to request Capital Metro to negotiate with its consultant team for a modification of the CCCTA work plan — eliminating the proposed 30-month “slow track” study, and re-directing the project into planning, design, and engineering of LRT for the Guadalupe-Lamar corridor as suggested above. This would have the aim of placing a measure on the ballot for bond funding (to be kept in escrow till further planning and Preliminary Engineering/Environmental Impact Study tasks are completed). Adequate cost estimates are already on hand for such a ballot measure.

According to Surinder Marwah, the former Capital Metro Senior Planner who secured federal funding for the MetroRapid bus project, this can be “a reasonable plan if the elected officials, business leaders and major stakeholders can come to an agreement” for the general Guadalupe-Lamar alignment corridor. “AECOM can update the preliminary cost estimates quickly and perform fatal flaw analysis for the alignment corridor within few months — by mid-late August to get this into [a] November ballot measure.”

Capital Metro’s currently contrived CCCTA study seems little more than a “holding pattern” reflecting the indecisiveness and lack of will of key public officials in regard to public transport policy. Re-directing this study as proposed above would at long last move Austin’s rail public transport development into a widely supported action phase and head it expeditiously toward the mobility quantum leap Austinites have so long been denied. ■
