Archive for August, 2014

h1

Reality Check: How plausible are Project Connect’s time/speed claims for Highland-Riverside urban rail plan?

24 August 2014
LEFT: Phoenix's Metro LRT — similar to Project Connect's proposed Highland-Riverside line — runs almost entirely in street and arterial alignments, with maximum speed limits, traffic signal interruptions, and sharp turning movements that slow running speed. Average schedule speed: 18.0 mph. (Photo: OldTrails.com)  RIGHT: Charlotte's Lynx LRT runs entirely in an exclusive alignment following a former railway right-of-way. Average schedule speed: 23.0 mph. (Photo: RailFanGuides.us)

LEFT: Phoenix’s Metro LRT — similar to Project Connect’s proposed Highland-Riverside line — runs almost entirely in street and arterial alignments, with maximum speed limits, traffic signal interruptions, and sharp turning movements that slow running speed. Average schedule speed: 18.0 mph. (Photo: OldTrails.com) RIGHT: Charlotte’s Lynx LRT runs entirely in an exclusive alignment following a former railway right-of-way. Average schedule speed: 23.0 mph. (Photo: RailFanGuides.us)

In a Blitzkrieg of promotional presentations over the past several months, Project Connect leaders and team members have been touting ambitious travel time and average speed projections for their urban rail project proposed to connect the Highland ACC site with the East Riverside development area. In various presentations, the agency’s Urban Rail Lead, Kyle Keahey, has claimed that the line would provide an average speed of “21 to 22 miles per hour” (impressive, compared to an average of about 25 mph for motor vehicles in urban traffic, and typical local bus transit averages of about 12 mph generally and 4-8 mph running through a in a CBD).

In terms of travel time on Project Connect’s proposed line, the agency has detailed the following:

• From the East Riverside terminus at Grove to the Convention Center downtown (3.9 miles) — 11 minutes

• From the Convention Center to the ACC Highland campus (5.6 miles) — 17 minutes

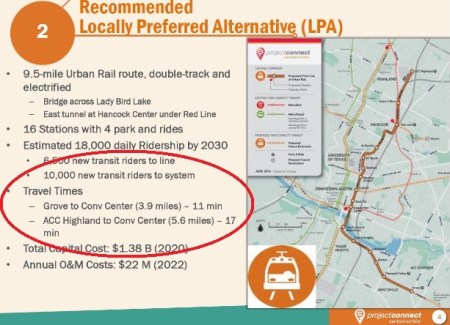

Screenshot from Project Connect's June 23rd presentation to Capital Metro board, showing travel time claims for proposed urban rail project.

Screenshot from Project Connect’s June 23rd presentation to Capital Metro board, showing travel time claims for proposed urban rail project. (Click to enlarge.)

However, several anomalies immediately leap out to experienced public transit analysts. First, the distance and time projections provided by the agency — totaling 9.5 miles in 28 minutes — imply an average speed of 20.4 mph, not the “21-22” claimed by Kyle Keahey and other representatives. Second, even an average speed of 20.4 for this type of light rail transit (LRT) service in this kind of application raises professional eyebrows (and considerable skepticism) — mainly because it’s significantly higher than what is commonly characteristic of peer systems.

Light rail transit planners commonly know that lines routes in street and arterial alignments, even reservations, face substantially more constraints to speed than do systems routed in exclusive, private right-of-way (ROW) alignments such as railway corridors, tunnels, viaducts, etc. (This is illustrated in the photo composite at the top of this post.) Some major constraints include: maximum speed limited to traffic maximum speed; operation constrained by traffic signals and cross-traffic; sharper curves and turning movements as route follows street grid. Compared with routes in exclusive alignments, the differentials usually aren’t tremendous, but enough to make a difference in schedule speeds, travel times, and other performance factors.

To illustrate this, and perform a rough comparative analysis, we’ve compiled average speeds from two sources. The first is a comparison on the Light Rail Now website, in an article titled Light Rail Schedule Speed – Faster Than Bus, Competitive With Car, with speeds summarized in the following table:

Table of LRT average schedule speeds from Light Rail Now website.

Table of LRT average schedule speeds from Light Rail Now website.

The second source is a recent compilation by Light Rail Now publisher Dave Dobbs, summarized with route lengths, average stop spacing, travel times, and average speeds, in the table below:

Table of LRT average schedule speeds and other data compiled by Dave Dobbs.

Table of LRT average schedule speeds and other data compiled by Dave Dobbs. (Click to enlarge.)

Dave notes that he included the lines he did “because they were examples from Project Connect slides.” He also points out that Project Connect’s East Riverside-to-Highland line “is virtually all street running save for the tunnels and the bridge and I don’t see that much time saving there.”

Indeed, Project Connect’s proposed line is far more of a winding, meandering route, with more traffic speed constraints and sharper turning movements, than any of the comparative peer street-running systems. It includes running in mixed traffic (Red River St.) as well as a segment through the UT campus (San Jacinto Blvd.) with heavy student pedestrian traffic crossing the alignment.

LRT systems are identified with the following designations:

BAL — Baltimore
CHA — Charlotte Lynx
DAL — Dallas DART
HOU — Houston MetroRail Red Line
LA — Los Angeles
MIN — Minneapolis-St. Paul Metro
NFK — Norfolk Tide (Hampton Roads Transit)
PHX — Phoenix Metro
SEA — Seattle Link
SLC — Salt Lake City TRAX

To simplify this comparison, we’ve included clearly identifiable route segments from both table sources, and differentiated them into Predominately Street Alignment and Predominantly Exclusive Alignment categories. For several individual systems, segments are identified in our charts as follow:

Dallas
CBD — West End to Pearl/Arts
Green Line A — West End to Fair Park
Blue Line A — West End to Ledbetter
Blue Line B — West End to Corinth
Blue Line C — Corinth to Illinois
Red Line A — CBD to Plano

Denver
Littleton — CBD to suburb of Littleton

Houston
Red — Red Line

Los Angeles
Blue — Blue Line, CBD to Long Beach

Minneapolis
Blue — Blue Line, Hiawatha
Green — Green Line, Minneapolis-St. Paul

Salt Lake City
701 — Medical Center to Ball Park
704 — West Valley Central to Airport
Sandy — CBD to suburb of Sandy

Using the data from these tabular compilations, we’ve presented a comparative summary of average schedule speeds in the following two graphs. Speed data values (mph) have been rounded to a single decimal point. The first graph presents a comparison of various predominantly street-running lines, similar to Project Connect’s proposed project. This includes an average for the actual, operating peer systems. The second graph presents average speeds for various lines and line segments in exclusive (mostly railway right-of-way) alignments. (Click either graph to enlarge.)

5_ARN_Chart-LRT-mph-street

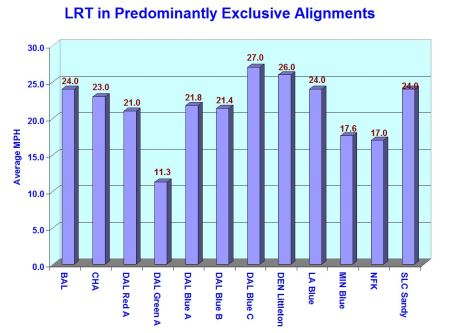

6_ARN_Chart-LRT-mph-exclusive-rev

From this comparison, it can be seen that the average speed for Project Connect’s Highland-Riverside line, based on the projected travel time presented by the agency, is significantly above all of the peer systems running predominantly in street right-of-way. Not only does Project Connect’s line show a higher average schedule speed than any of its peer systems, but it’s a full 6.4 mph — nearly 46% — above the peer average. This seems highly implausible, particularly in view of the more convoluted, tortuous profile of the proposed alignment and the other encumbrances we’ve cited. Indeed, the travel time (and implicitly schedule speed) assumptions of Project Connect planners seem more appropriate for the operating characteristics of a route in predominantly exclusive right-of-way rather than running on streets and arterials, as they’ve designed it.

Projecting reasonably accurate travel times and speeds is important to planning any rail transit project, and not just because of plausibility with respect to public scrutiny. Travel time constitutes one of the key inputs into the ridership modeling process. Underestimating travel time, by reducing what’s called the “impedance” to the process of calculating trip generation and modal split, can readily lead to overestimation of ridership. In addition, slow travel speeds also raise the possible need for additional rolling stock to fulfill train frequency and passenger capacity requirements.

Bottom line: Project Connect planners may be estimating faster train travel speeds and shorter travel times than is realistically plausible, and the implications may be lower ridership, greater rolling stock requirements, and possibly higher operating costs than they’ve originally projected.

Advertisement
h1

Baker: Connecting some dots on Austin’s urban rail planning

24 August 2014
Graphic by ARN.

Graphic by ARN.

By Roger Baker

Roger Baker is a longtime Austin transportation, energy, and urban issues researcher and community activist. The following commentary has been adapted and slightly edited from his comments posted by E-mail to multiple recipients in June.

How did Project Connect come up with their $1.4 billion rail plan? Let’s take some known facts, and connect the dots. The dots in this case were partly the political momentum behind a new hospital district, combined with a new Opportunity Austin/Chamber-of-Commerce-recommended Austin growth policy.

We know that in 2008, a city consultant, ROMA, recommended that the proposed light rail corridor be moved east to the San Jacinto Corridor (ultimately connecting several years later to the Red River corridor), as opposed to the previously-assumed Lamar Corridor alignment. See, for example:

http://www.austinchronicle.com/news/2008-04-25/616178/

Original urban rail "circulator" system in 2008 map of ROMA consulting team plan, contracted by City of Austin.

ROMA streetcar circulator map from 2008, precursor of urban rail (light rail transit) plan. Map: ROMA, via Austin Chronicle. (Click to enlarge.)

Next, we know that State Sen. Kirk Watson in 2012 announced a plan to develop about $4 billion of future medical facilities and training in the area of Brackenridge and the newly announced Dell medical training center, which would be along this same San Jacinto-Red River corridor. It is pretty obvious that to meet this ambitious goal, to handle this scale of future anticipated development, the existing roads along this corridor could not meet the projected travel demand. I pointed that out in an earlier article here:

http://www.theragblog.com/metro-roger-baker-the-proposed-austin-light-rail-plan-as-i-see-it/

How did the urban rail plan get to Riverside? Here is a downloadable audio clip with Project Connect personnel pointing out that the city sees itself as having an unfunded mandate to provide rail on the Riverside alignment in order to meet the city’s future growth goals in that area:

https://docs.google.com/file/d/0B9kg5NdhKh8RYTM0dzQ4ampmeWs/edit

East Riverside development plan, promoted by City, is a bonanza for powerful real estate development interests. Gentrification is replacing lower-cost affordable apartments with expensive condos and upscale commercial and office developments, many with premium river views. Map: City of Austin via Goodlife Realty.

East Riverside development plan, promoted by City, is a bonanza for powerful real estate development interests. Gentrification is replacing lower-cost affordable apartments with expensive condos and upscale commercial and office developments, many with premium river views. Map: City of Austin via Goodlife Realty. (Click to enlarge.)

Another problem for the medical district was that Texas state funding could not pay for the medical center without a big boost from local Travis taxpayers. This demanded the promotion of a hospital district tax. See, for example:

http://www.kirkwatson.com/the-med-school-solution/

…Ever since Austin state Sen. Kirk Wat­son first unveiled the idea at a Real Estate Council of Austin event last September, regional agencies and governments have scrambled to find funding possibilities for the massive project, which could run the involved parties (all told) as much as $4.1 billion over 12 years. At last check, the University of Texas is on board for at least a $25 million annual contribution that would climb to $30 million over the first eight years of the school’s existence. Central Health, according to the Statesman, would cough up about $35 million annually over 12 years – or a total of $420 million. The Seton Healthcare Family expects to provide nearly $2 billion, including $250 million that would ultimately result in a replacement of its aging but centrally located Brackenridge hospital facility…

But to make it all work, Central Health is asking for a tax increase, to be placed before voters on Nov. 6. Watson asked for a raise of five cents per $100 of property valuation; Central Health’s board obliged, endorsing that increase, which would bring the district’s rate to just over 12 cents for every $100 of property valuation. In dollar figures, that would mean (if voters approve) that someone who lives in a home valued at $200,000 would see an increase of $100 on their annual tax bill…

Simulation of future UT medical school development, providing expansion opportunities for University of Texas, Seton medical interests, and other real estate development investors. Graphic via KUT.org.

Simulation of future UT medical school development, providing expansion opportunities for University of Texas, Seton medical interests, and other real estate development investors. Graphic via KUT.org. (Click to enlarge.)

We know from the following document that the city of Austin is bending over backwards to maximize Austin area growth through relocation, and jobs recruitment to the Austin area.

http://www.austintexas.gov/news/city-releases-report-economic-incentives

As we can see, the City has a very well-developed industrial recruitment policy outlined in this document, which coordinates with the Chamber of Commerce, targets key industries to recruit, and gives tax breaks when certain criteria are met. The city takes its lead from the “Council Special Committee on Economic Incentives”, which in turn takes its lead from Opportunity Austin, and the Austin Chamber of Commerce, as we see in this lengthy presentation. It begins by lamenting Austin’s slow growth!

http://austintx.swagit.com/play/08272012-504

We now see unsigned blogs promoting the same maximum Austin growth recruitment as official policy:

http://www.austintexas.gov/department/about-imagine-austin

What are the specifics of Austin growth recruitment policy? The policy is to prefer that at least 25% of the jobs recruited into this area go to Austin residents, but if not, it is no deal breaker. Jobs that pay at least $11 an hour would be nice, but this too is considered optional. This is taken from page 9.

http://www.austintexas.gov/sites/default/files/files/EGRSO/EGRSO_Report_on_ED_Policy_Final.pdf

REPORT AND RECOMMENDATIONS ON THE COA ECONOMIC DEVELOPMENT POLICY

Motion #5:

Change the Threshold for Extraordinary Economic Impact within the Firm-Based Matrix to include other items

The Threshold for Extraordinary Economic Impact has been used within the Firm-Based Incentive Matrix as a means for providing additional economic incentives for significant economic development projects.

Currently, if a company meets one of the four criteria within this section of the matrix, then the company is eligible for an economic incentive of up to 100% of the property tax generated by the project (see Exhibit A, Section 3 and Section 4).

Current threshold criteria include these four items:

• The firm is in a targeted industry;
• The firm is involved in leading edge technology;
• State economic development funds are available for the firm; or
• The firm will generate 500 jobs or more.

The threshold criteria allow flexibility for various economic incentive options to be considered for projects that have an extraordinary economic impact. The flexibility allows Austin to remain competitive for highly sought after projects. Examples of prior significant economic development projects include Samsung and Apple. In both cases, the Austin City Council approved 100% property tax rebates for a prescribed number of initial years…

This is all predicated on the perpetuation of the Austin tech bubble, which is really a regional manifestation of a national tech bubble. Continuing Federal Reserve stimulus is leading to asset bubbles, which are reflected in the NASDAQ’s mostly-tech growth in particular. How long before the tech bubble driving Austin’s current feverish growth and gentrification deflates is anyone’s guess, as Fortune recently pointed out:

http://fortune.com/2014/05/08/yes-were-in-a-tech-bubble-heres-how-i-know-it/

I have recently pointed out and discussed in detail the unsustainable nature of Austin’s currently-booming growth here:

http://www.theragblog.com/metro-roger-baker-the-rise-and-rise-of-austin/

This accumulation of material may help to provide a plausible political basis behind Project Connect’s rail plan. I personally have little doubt that Austin is in the midst of an unsustainable high tech growth bubble, and that the future travel demand numbers that Capital Area Metropolitan Planning Organization (CAMPO) feeds Project Connect to justify its rail corridors are largely wishful thinking. Demographic forecasting, like economic forecasting, exists to make astrology look good by comparison. ■

h1

Why Project Connect’s urban rail plan would remove just 1,800 cars a day — not 10,000

22 August 2014
Project Connect's Highland-Riverside alignment would have negligible impact on I-35 congestion. Photo via Austin.CultureMap.com.

Congested I-35 traffic has Austinites desperate for a solution, but Project Connect’s Highland-Riverside alignment would have negligible impact. Photo via Austin.CultureMap.com.

Project Connect representatives have been claiming an array of hypothetical benefits they say would result from their proposed Highland-Riverside urban rail project. Among these is “congestion relief”.

For the most part, this sweeping claim has been blurry, undefined, unquantified, and widely dismissed as ridiculous. (See Why Project Connect’s “Highland” urban rail would do nothing for I-35 congestion.)

But in promotional presentations, Project Connect personnel and supporters have repeatedly touted one specific, numerically quantified purported benefit — the claim that their urban rail project “takes 10,000 cars off the road every weekday”.

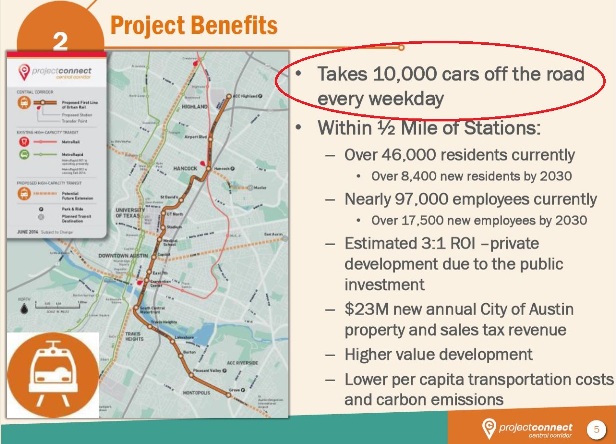

Screenshot from Project Connect slide presentation claiming Highland-Riverside rail plan would remove "10,000 cars" a day.

Screenshot from Project Connect slide presentation claiming Highland-Riverside rail plan would remove “10,000 cars” a day. (Click to enlarge.)

This figure invites scrutiny. Project Connect has also been touting a 2030 ridership projection of “18,000 a day” — although this appears to rely on flawed methodology. (See our recent analysis Project Connect’s urban rail forecasting methodology — Inflating ridership with “fudge factor”? which, adjusting for apparent methodological errors, suggests that total ridership of 12,000 per weekday is more plausible.)

In any case, of its projected total weekday ridership, Project Connect also claims that only 6,500 are “new transit riders” for the urban rail line. (Project Connect also claims “10,000 new transit riders to system” — but typically these new “system” boardings represent the combination of the new rail rider-trips plus the same passengers using feeder bus routes to access the rail.) This is consistent with industry experience, since a sizable proportion of the ridership of new rail services consists of passengers that had previously been bus transit riders.

But this “new transit riders” figure, while plausible, immediately diminishes the plausibility of the claim of “taking 10,000 cars off the road”. How could 6,500 riders, boarding trains, eliminate 10,000 cars from the road?

Furthermore, the estimate of 6,500 rider-trips (i.e., boarding passengers) actually doesn’t equal 6,500 individual passengers, i.e., persons. Why? Because (as is commonly known and accepted in the industry) a very large percentage of those trips are made by the same, individual passengers — mainly round trips, or extra trips during lunch hour, and so on.

The count of daily “boardings”, or rider trips — i.e., ridership — is actually a tally, in U.S. industry parlance, of unlinked trips. These are the string of trips on transit made over a day by the same individual person; they might include trips on a feeder or connector bus to a rail transit train, possibly other trips during the day by transit, and perhaps that person’s return trips back home by the same modes.

So, how to figure how many individual passengers (persons) are actually involved in a given ridership figure? The American Public Transportation Association (APTA) suggests a conversion factor: “APTA estimates that the number of people riding transit on an average weekday is 45% of the number of unlinked transit passenger trips.”

Thus, applying that 45% factor to those 6,500 “new rider” trips, we realize that figure represents roughly 2,925 actual passengers projected to ride the proposed urban rail line, new to the transit system.

However, we cannot assume that every one of those new passengers would have used a motor vehicle rather than riding transit. On average, about 75% have access to a car. So 2,925 passengers X 75% = 2,194 passengers that could be assumed to leave their cars off the road to ride transit. (It’s pretty much a cinch that these hypothetical transit passengers wouldn’t be driving, on average, more than four cars a day!)

To estimate more realistically how many cars would be affected, we need to factor in average car occupancy of 1.2 persons per car (to account for some carpooling). That final calculation yields 1,828 — or (by rounding for level of confidence) roughly 1,800 cars removed from the road by Project Connect’s proposed urban rail plan.

That 1,800 is an all-day figure. Using an industry rule-of-thumb of 20%, about 400 of those cars would be operated during a peak period, or roughly 100, on average, during each peak hour. As our article on I-35 congestion, cited above, indicates, the impact on I-35 traffic would be very minimal. Most of the effect of that vehicle traffic elimination would be spread among a number of major arterials — particularly Airport Blvd., Red River St., San Jacinto Blvd., Trinity St., and Riverside Drive. This impact on local arterial congestion would be small — but every little bit helps.

While the removal of 1,800 cars from central Austin roads is a far cry from 10,000, once again, every incremental bit helps. And there’s also the decreased demand for 1,800 parking spaces in the city center.

But the point is that $1.4 billion (about $1.2 billion in 2014 dollars) is a huge investment to achieve so little. For many cities, ridership at the level of 12,000 a day typically isn’t so bad, but when you’re missing the potential of 35,000-45,000 a day, plus incurring such a high cost for this level of payoff, you need to reconsider the deal. (For example, see Austin’s 2000 light rail plan — Key documents detail costs, ridership of Lamar-Guadalupe-SoCo route.)

For less than half of Project Connect’s urban rail investment cost, a “backbone” urban rail line on Guadalupe-Lamar (with a branch to the Seaholm-Amtrak area) could plausibly be expected to generate at least three times as much ridership — and eliminate roughly 5,600 cars a day from central-city streets and arterials.

Summary chart compares Project Connect's claim of taking "10,000 cars off the road every weekday" vs. (1) ARN's analysis of probable actual number of cars removed by Highland-Riverside line and (2) projected number of cars that would be removed from Austin's roadways by alternative Guadalupe-Lamar urban rail plan.

Summary chart compares Project Connect’s claim of taking “10,000 cars off the road every weekday” vs. (1) ARN’s analysis of probable actual number of cars removed by Highland-Riverside line and (2) projected number of cars that would be removed from Austin’s roadways by alternative Guadalupe-Lamar urban rail plan. (Click to enlarge.)

Now, that’s some “congestion relief” worth paying for.

h1

Project Connect’s gold-plated Austin urban rail plan shows planning process way off course

15 August 2014
Graphic: GG2.net

Graphic: GG2.net

By Lyndon Henry

The following comments were made during Citizen Communications to the City of Austin’s Urban Transportation Commission on 10 June 2014 regarding Project Connect’s proposed 9.5-mile, $1.4 billion urban rail starter line connecting East Riverside (southeast) with the Highland ACC site now under development (north). In the end, the commission voted, with minor amendments, to recommend Project Connect’s proposal to the City Council.

There are three huge problems with Project Connect’s proposal:

(1) It spends $1.4 billion to put urban rail in the wrong place.

(2) It will hinder and constrain future rail development.

(3) A vote for this flawed plan is also a vote to permanentize lower-capacity MetroRapid bus service in our strongest, densest travel corridor, Guadalupe-Lamar.

Guadalupe-Lamar is the outstanding corridor to start urban rail — among the top heavy travel corridors in Texas, a long-established commercial district, with major activity centers, the city’s core neighborhoods, and the West Campus, having the 3rd-highest residential density in Texas.

In contrast, Project Connect proposes to forsake the central city’s heaviest and densest local corridor and instead connect a weak corridor, East Riverside, with a non-existent travel corridor through the East Campus, Hancock, and Highland. By wasting over a billion dollars on urban rail in this meandering, misguided route, Project Connect will divert scarce funds from future rail development.

Project Connect’s Riverside-East Campus-Hancock-Highland plan comes “gold-plated” with a new $130 million “signature bridge” over the river and a $230 million tunnel at Hancock. But it runs in mixed street traffic from UT to Hancock. This is a proposal that costs too way much for too little value.

And it’s the third most pricey urban rail starter line, by cost per mile, in U.S. history. City officials now routinely propose a major property tax increase to finance the local share of Project Connect’s plan.

Per mile of route, proposed Highland-Riverside urban rail plan would be second most expensive light rail starter line since 1990, and third most expensive in U.S. history.

Per mile of route, proposed Highland-Riverside urban rail plan would be second most expensive light rail starter line since 1990, and third most expensive in U.S. history. Graph: ARN. (Click to enlarge.)

Voting for Project Connect’s urban rail plan for East Riverside to Highland also means voting to pour concrete for bus lanes and other bus facilities on Guadalupe and Lamar that will prevent an urban rail alternative in our heaviest, neediest corridor for decades. The current MetroRapid bus service on Guadalupe, Lamar and South Congress carries 6,000 daily riders, less than one-eighth of the 51,000 forecast for light rail in that same corridor.

According to a report yesterday from a private meeting of urban rail “stakeholders” at Capital Metro, representatives of both Project Connect and Capital Metro admitted that Phase 1 of this project, which conjured up Looney-Tunes voodoo and passed it off as “scientific” projections, was “too fast and not at a pace they would typically have proceeded.”

In contrast to major rail planning in the past, the public has basically been cut out of this process. Now Mayor Leffingwell and his administration announce they’re tossing in a dollop of road projects that even some councilmembers criticize as failing to fit into the Imagine Austin concept of a walkable, dense city. In effect, they’re packaging a dubious, wasteful rail project with questionable road projects, and wrapping a “congestion relief” ribbon around it.

This is a planning process that’s gone off course and out of control. This commission needs to do the right thing, and say as much to the city council. ■

Related links:
Project Connect’s $500 million plan for bus infrastructure — The Elephant in the Road on Guadalupe-Lamar that could block urban rail
Project Connect’s Austin urban rail would be 3rd-most-pricey LRT starter line in U.S. history
Roger Baker: Austin’s ‘Strategic Mobility Plan’ — smart planning or a billion dollar boondoggle?
h1

Project Connect gets it wrong — Urban rail starter lines are much cheaper than extensions

14 August 2014
LEFT: Denver's starter LRT line, a 5.3-mile line opened in 1994, was routed and designed as a simple, surface-routed project to minimize construction time and cost. All-surface alignment avoided heavy, expensive civil works and kept design as simple as possible. Photo: Peter Ehrlich. RIGHT: Subsequent extensions, such as this West line opened in 2013, have required bridges, grade separations, and other major civil works, resulting in a unit cost 61% higher than that of the starter line. Photo: WUNC.org.

LEFT: Denver’s starter LRT line, a 5.3-mile line opened in 1994, was routed and designed as a simple, surface-routed project to minimize construction time and cost. All-surface alignment avoided heavy, expensive civil works and kept design as simple as possible. Photo: Peter Ehrlich. RIGHT: Subsequent extensions, such as this West line opened in 2013, have required bridges, grade separations, and other major civil works, resulting in a unit cost 61% higher than that of the starter line. Photo: WUNC.org.

Since Project Connect released the cost estimates for their proposed 9.5-mile Highland-Riverside urban rail starter line last spring, agency representatives have tried to argue that the line’s projected cost of $144.8 per mile (2020 dollars) is comparable to that of other recent light rail transit (LRT) projects, citing new extensions in Houston, Portland, and Minneapolis.

Project Connect's chart comparing their proposed Highland-Riverside "Austin Urban Rail" starter line cost to costs of extensions of several other mature light rail transit systems.

Project Connect’s chart comparing their proposed Highland-Riverside “Austin Urban Rail” starter line cost to costs of extensions of several other mature light rail transit systems. (Click to enlarge.)

Austin Rail Now challenged this comparison In our recent analysis, Project Connect’s Austin urban rail would be 3rd-most-pricey LRT starter line in U.S. history. We argued that comparing the high cost of extensions of other, mature systems, was invalid, because urban rail starter lines tend to be much lower in cost than subsequent extension projects.

That’s because, in designing a starter line — the first line of a brand-new system for a city — the usual practice is to maximize ridership while minimizing costs through avoiding more difficult design and construction challenges, often deferring these other corridors for later extensions. In this way, the new system can demonstrate sufficient ridership and other measures of performance sufficient to convince both local officials and the public that it’s a success from the standpoint of being a worthwhile investment.

In contrast with starter lines, where officials and planners usually strive to keep design minimal and hold costs down in order to get an initial system up and running with the least demand on resources (and public tolerance), extension projects more often are deferred to later opportunities, mainly because they frequently contend with “the much more difficult urban and terrain conditions that are typically avoided and deferred in the process of selecting routes for original starter systems.” Deferring more difficult and expensive alignments till later also allows time for public acceptance, and even enthusiasm, for the new rail transit system to take root and grow.

Austin’s case provides an illustration. As our article, Austin’s 2000 light rail plan — Key documents detail costs, ridership of Lamar-Guadalupe-SoCo route, describes, Capital Metro’s original 2000 LRT plan envisioned a “Phase 1” 20-mile system consisting of a 14.6-mile line from McNeil to downtown, plus a short branch to East Austin and a longer extension down South Congress to Ben White Blvd. In Year of Expenditure (YOE) 2010 dollars, that full system was projected to cost $1,085.8 million (about $1,198 million in today’s dollars). But a billion-dollar project was deemed too hefty a bite for the city’s first foray into rail, so decisionmakers and planners designated the shorter 14.6-mile northern section as a Minimum Operable Segment (MOS), with a more affordable (and, hopefully, more politically palatable)pricetag of $739.0 million in 2007 YOE dollars (roughly $878 million in current dollars).

After an initial starter line is established, for most subsequent extension projects the unit cost — per mile — tends to increase because, as previously indicated, officials and designers are willing to tackle more daunting corridors and alignments. Denver is a useful example.

In 1994 Denver established basic LRT service with a comparatively simple 5.3-mile starter line, running entirely on the surface in both dedicated street lanes and an available, abandoned center-city railway alignment, with an installation cost of $37.3 million per mile (2014 dollars). From that beginning, the system has been gradually expanded with increasingly more ambitious and more costly extensions. In 2013, Denver opened its West Line (the W line) to Golden; constructed over much more daunting terrain and obstacles, with multiple grade separations, bridges, and long elevated sections, plus more complex signal and communications systems and more elaborate station facilities. The West line was finished at a cost in 2014 dollars of about $59.9 million per mile — a unit cost about 61% higher than that of the original starter line.

Despite such evidence, at an Aug. 5th urban rail forum sponsored by the Highland Neighborhood Association, Project Connect’s Urban Rail Lead, Kyle Keahey, dismissed the assertion that starter lines were lower in cost per mile than extensions. Instead, he insisted, “the reverse is true.”

Really? But this claim is refuted even by the same cases that Project Connect has presented as peer projects for comparing the estimated $144.8-million-per-mile cost (2020) of its Highland-Riverside proposal.

In the following comparative analysis, we use Project Connect’s own year-2020 cost-per-mile figures for their selected “peer” projects. For each of those we use the starter line cost-per-mile data from our earlier May 8th article (cited above), plus data for Portland’s original starter line (a 15.1-mile line opened in 1986 from central Portland to the suburb of Gresham). These unit costs, in 2014 dollars, were then escalated to year-2020 values via the 3% annual factor specified by Project connect for their own table data.

The resulting comparison is shown below:

Using Project Connect's selected LRT systems, this comparison shows that the cost per mile of new starter lines tends to be significantly less than the cost of later extensions. Graph: ARN.

Using Project Connect’s selected LRT systems, this comparison shows that the cost per mile of new starter lines tends to be significantly less than the cost of later extensions. Graph: ARN. (Click to enlarge.)

Clearly, this analysis corroborates our original assertion — based on these cases, the unit costs of LRT starter lines tend to be considerably lower than the unit cost of later extensions when these have developed into more mature systems. And, at $144.8 million per mile, the unit cost of Project Connect’s proposed 9.5-mile Highland-Riverside urban rail starter line is certainly far higher than the cost of any of the original starter lines of these selected systems — all using Project Connect’s own cases and criteria.

Q.E.D., perhaps? ■

h1

Official urban rail plan bulldozed to ballot — in bulging bundle

11 August 2014
City Council's Aug. 7th urban rail ballot measure was included in massive bundle with other disparate items. Graphic: Glogster.com.

City Council’s Aug. 7th urban rail ballot measure was included in massive bundle with other disparate items. Graphic: Glogster.com.

With about as much suspense and excitement as, well, making sausage, the Austin City Council this past Thursday, Aug. 7th, finally rammed through the official (and seriously flawed) Highland-Riverside urban rail plan to the next big step — a ballot item placed up for voters’ approval (or rejection) this coming Nov. 4th.

While Austin transportation officials and some Project Connect representatives have tried to radiate a public image of “openness”, “transparency”, “fairness”, sweetness, and cooperation in their pursuit of their urban rail agenda, the machinations, subterfuges, and intrigues involved with this Council vote expose a more troubling reality. This consistently ruthless, damn-the-torpedoes, bulldoze-the-opposition functional style for well over a year has dismayed, outraged, disgusted, and angered a wide swath of the Austin community who have consistently felt shut out of bona fide participation in the public transportation planning process. (See, for example: City Council to Austin community: Shut Up; Will Project Connect continue to gag the public?; City Council to Central Austin: Drop Dead; Meetings, “open houses”, workshops … and democratic process.)

Another move to gag public criticism

The Council’s Aug. 7th vote shenanigans seemed to draw from this same playbook. Perhaps the most salient indication of this is the City administration’s bundling of the urban rail bond measure in a single ordinance with the totally unrelated authorization of the vote for the new “10-1” Council. Item #17 on the council’s Aug. 7th agenda proposed to

Approve an ordinance ordering a general municipal election to be held in the City of Austin on November 4, 2014, for the purpose of electing a Mayor (at large) and City Council Members (single member districts) for District 1, District 2, District 3, District 4, District 5, District 6, District 7, District 8, District 9, and District 10; ordering a special election for the purpose of authorizing the issuance of general obligation bonds; providing for the conduct of the election; authorizing the City Clerk to enter into joint election agreements with other local political subdivisions as may be necessary for the orderly conduct of the election; and declaring an emergency.

By packaging all this — in effect, the basic election of the new Council itself — in a single “kitchen sink” ordinance, the smooth operators of the current administration thus set up the ordinance so that if a current councilmember would vote against the urban rail/transportation proposals (highly unlikely in any case, given all the strong-arming behind the scenes), he/she would also be voting against calling the election for the new council. Most likely, the real intent of this maneuver was probably to place community opponents of the urban rail bond plan in the awkward position of calling for a No vote to the election of the new council if they called for a No vote against putting the bonds on the ballot. Thus, the tactic seemed yet another method of suppressing criticism and opposition. Machiavelli would surely be proud.

But the urban rail ballot ordinance wasn’t just “bulging” with the entire new Council vote authorization thrown into the package. The Aug. 7th ordinance also includes authorization for Capital Metro — the sales tax-supported transit authority — to allocate its own funds to an urban rail project with lots of amorphous pieces and blurry edges:

As contemplated by the Locally Preferred Alternative contained in the 2014 Strategic Mobility Plan approved by Council on June 26, 2014, the fixed rail transit system is expected to consist of a 9.5 mile urban rail double-tracked, electrified route in mostly dedicated guideways. The general location of the proposed route of the fixed rail transit system is expected to run along a route that will serve the East Riverside Corridor, downtown Austin, the State Capitol complex, the Medical School complex, the University of Texas, Hancock Center, Austin Community College Highland campus, and surrounding neighborhoods. The general description of the form of the fixed rail transit system, including the general location of the proposed route, is provided herein pursuant to Section 451.071, Texas Transportation Code, to authorize Capital Metropolitan Transportation Authority to participate and to spend its funds in building, operating and maintaining the fixed rail transit system. The final alignment of the route may be adjusted to accommodate any required governmental approvals and to maximize service characteristics, including stop spacing, speed, frequency, and reliability. Capital Metropolitan Transportation Authority shall participate in building, operating and maintaining the fixed rail transit system to the extent and pursuant to such terms and conditions as shall be mutually acceptable to the City and Capital Metropolitan Transportation Authority.

Road projects potentially dwarf rail

However, the really huge, disjointed component of this ballot package has been the focus of leaks, news reports, and small dollops of information for weeks. As is now widely known, a hefty assortment of major roadway projects were included in a cumbersome, disparate hodgepodge hastily contrived and christened the “2014 Strategic Mobility Plan”.

According to leaks and hints in news reports, bundling hundreds of millions of dollars’ worth of road projects with the rail proposal had been demanded by major pro-highway business interests as a condition for their support and the contribution of a million dollars to the prospective war chest for Project Connect’s ballot initiative campaign. The result was the “2014 Strategic Mobility Plan” (SMP), reportedly designed to appease the prevailing leadership of groups such the Greater Austin Chamber of Commerce and Real Estate Council of Austin with $400 million of politically selected road project sweeteners.

Council's ballot measure makes urban rail funding contingent on road construction projects potentially more expensive than rail. Photo: Robert Miller, via TexasFreeway.com.

Council’s ballot measure makes urban rail funding contingent on road construction projects potentially more expensive than rail. Photo: Robert Miller, via TexasFreeway.com.

Another “sweetening” factor: Federal funding match for road projects is typically far higher than for transit; for Interstate highway system projects, the nominal Federal Highway Administration (FHWA) match is 90%. Thus, the $240 million of I-35 projects listed in the SMP could well facilitate projects of $2.4 billion in actual magnitude. And the other federal-system road projects in the SMP could also receive outsized FHWA matching grants. Plus contributions by the Texas Department of Transportation (TxDOT).

In contrast, the rail project is expected, at best, to qualify for just 50% Federal Transit Administration match, implying a maximum project of about $1.2 billion. Thus, under the “green” facade of “urban rail”, the SMP package is a rubber-and-asphalt-oriented concoction in which the potential highway projects grotesquely dwarf the rail component.

City's "2014 Strategic Mobility Plan" is packed with road projects that must be funded before urban rail bonds can be issued. Potential cost dwarfs cost of rail. ("Future Phases of Urban Rail" dashed lines on map are likely just sucker bait to lure support from gullible voters; fine print specifies merely "high-capacity transit" which could mean "bus rapid transit", term used to describe MetroRapid bus service.) Map: Screenshot from SMP.

City’s “2014 Strategic Mobility Plan” is packed with road projects that must be funded before urban rail bonds can be issued. Potential cost (including federal and state match) dwarfs cost of rail. (“Future Phases of Urban Rail” dashed lines on map are likely just sucker bait to lure support from gullible voters; fine print specifies merely “high-capacity transit” which could mean “bus rapid transit”, term used to describe MetroRapid bus service.) Map: Screenshot from SMP. (Click to enlarge.)

As City of Austin officials endeavored to craft the ballot language for the “roads + rail” bond package, they at first envisioned a combined $1 billion package ($600 million rail + $400 million roads). However, they hit a snag: Texas law forbids the bundling of such bonds. To avoid a deal-killer with the pro-road interests, a peculiar work-around was conceived — zap the bond proposal for the roads component, but make the rail bonds contingent on “providing” $400 million of unspecified road works funding! We’re not kidding!

At first most news media reporters and journalists were fooled, reporting the Council’s Aug. 7th ordinance as placing “a one-billion-dollar bond package” on the ballot. But their stories were quickly revised to report a $600 million rail bond package, plus the cumbersome, contingent road funding component, as they read the actual ballot language more closely:

The issuance of $600,000,000 bonds and notes for rail systems, facilities and infrastructure, including a fixed rail transit system to be operated by Capital Metropolitan Transportation Authority (which may spend its funds to build, operate and maintain such system) servicing the East Riverside Corridor, downtown Austin, the State Capitol complex, the Medical School complex, the University of Texas, Hancock Center, Austin Community College Highland campus, and surrounding neighborhoods, and roadway improvements related to such rail systems, facilities, and infrastructure; provided that the City may not issue bonds or notes to pay costs of the fixed rail transit system (other than expenditures for planning, designing and engineering) unless (i) the City obtains grant or match funding for the cost of the fixed rail transit system from the Federal Transit Administration or one or more other federal or state sources and (ii) the City provides funding in an amount not less than $400,000,000 to pay costs of roadway improvement projects of regional significance that are designed to relieve congestion, enhance mobility and manage traffic in the I-35, US 183, SH 71, RM 620, RM 1826, RM 2222, FM 734 (Parmer), Lamar Boulevard, and Loop 360 corridors; and the levy of a tax sufficient to pay for the bonds and notes.

More debt, but without public vote?

So where might this mysterious $400 million in road funding come from? Unless the City has a hidden cache of $400 million tucked away somewhere, almost surely this would require some form of debt financing. One option could be to place another bond measure on a future ballot asking voters to approve $400 million in additional City debt for these road projects.

However, as Austin community transportation activist and researcher Roger Baker has pointed out, other debt financing options are available that don’t require public votes, as do bonds. For example, there are Certificates of Obligation (COs), Anticipation Notes, and Time Warrants. Useful descriptions of such public funding alternatives can be found online in a “Public Finance Handbook” published by the Texas Association of Counties and a “Public Finance Issues” guide posted by Thomas M. Pollan with Austin-based Bickerstaff Heath Delgado Acosta LLP.

Of these alternatives, COs may be the leading choice for City of Austin and Project Connect leaders in their quest for a $400 million road project funding solution that avoids a risky and awkward public vote. As the Handbook cited above relates, “Unlike G.O. Bonds that always require an election, the CO’s do not require an election unless at least 5% of the registered voters in the county submit a valid petition protesting the issuance.” (Emphasis added.)

Often, the public entity may desire to sell the COs for cash “in order to have funds to pay contractors, equipment suppliers, and costs of issuance.” But there’s a catch — “The list for which CO’s may be sold for cash with only a tax pledge is limited…”, including fairly extraordinary situations such as “it is necessary to preserve or protect the public health of the residents” of the district holding the COs. (Emphasis added.)

Well, whaddaya know — lo and behold, the Austin City Council’s humongous hodgepodge ordinance, authorizing the new Council election, the urban rail bond election, and the kitchen sink, just happens to contain a Part 13 that — hold on to your chair — stipulates the following:

The Council finds that the need to immediately begin required preparations for this election constitutes an emergency. Because of this emergency, this ordinance takes effect immediately on its passage for the immediate preservation of the public peace, health, and safety. [Emphasis added.]

Hefty property tax rate increase

So how much would all this debt to preserve our “peace, health, and safety” cost us? Part 7 of the ordinance itself details the bad news:

As reported in the 2014 Strategic Mobility Plan, applying the assumptions used in the General Obligation Bond Capacity Analysis dated April 29, 2014, which includes forecasted growth in taxable assessed values, City financial staff has determined that, if the bonds and notes are issued, the City’s total tax rate would increase by $0.0625 per $100 of taxable assessed valuation (as compared to the City’s total tax rate as of the date of adoption of this ordinance) …

Even for fairly lower-middle-income and low-income homeowners, that implies an annual property tax bill increase of at least over $100. For average-income and homeowners and those at higher levels, it almost surely means an additional tax bite of at least several hundred dollars — an additional body-blow to taxpayers already seriously financially stressed with steep home valuation hikes, other prospective property tax increases, and hikes in electric and water service rates. Meanwhile, local officials continue to dispense seemingly endless giveaways from the public treasury to corporate interests (in exchange for dubious and largely undefined and untracked benefits).

Austin homeowners and other residents are steadily burdened with higher taxes and utility rates, with the rationale of vague "projections" of local "new jobs" and other benefits whose validity is never reliably tracked. Are massive subsidies to real estate developers, projects like the F1 racetrack, UT's East Campus expansion plans, the Medical Center development, a largely "showpiece" urban rail line, and other ventures worth this sacrifice?

Austin homeowners and other residents are steadily burdened with higher taxes and utility rates, with the rationale of vague “projections” of local “new jobs” and other benefits whose validity is never reliably tracked. Are massive subsidies to real estate developers, projects like the F1 racetrack, UT’s East Campus expansion plans, the Medical Center development, a largely “showpiece” urban rail line, and other ventures worth this sacrifice? Graphic: Active Rain website.

If what’s proposed were a worthwhile new urban rail line, cautiously implemented and cost-effective, that actually addressed true mobility problems, would local voters consider that a beneficial project worth paying for? Maybe.

But it may be hard for many voters to perceive any way the Highland-Riverside alignment proposed by the City of Austin on November’s forthcoming ballot solves, or even addresses, any real mobility needs or congestion problems. Particularly since it misses the city’s densest, most heavily traveled central corridor (Guadalupe-Lamar), with its string of major activity and employment centers plus the West Campus.

So, Austin voters need to ask themselves: Is this proposed line useful enough, and beneficial enough, to justify the cost to us? Are the land development goals of local real estate interests, and the East Campus expansion aims of the University of Texas, worthy of this much taxpayer subsidy?

The answer to those questions will come on November 4th. ■

h1

Legal, ethical questions persist over Project Connect’s ad blitz for urban rail plan

6 August 2014
Project Connect campaign ad as seen on a Yahoo.com news page in July 2014. Screenshot by ARN.

Project Connect campaign ad as seen on a Yahoo.com news page in July 2014. Screenshot by ARN.

More questions continue to be raised about Project Connect’s tax-funded ad blitz promoting its urban rail plan, almost certainly destined to be placed on the ballot for a vote this November. While this media campaign has intensified into a vigorous television barrage in recent weeks, Project Connect’s online ads — such as the example from a Yahoo.com News page at the top of this post — have been peppering webpages on the Internet for months

As we’ve noted in our previous article on this controversy (Project Connect’s tax-funded urban-rail-campaign ad blitz raises red flags), on July 11th, the pro-rail group Austinites for Urban Rail Action (AURA) issued a public statement, addressed to the board of Capital Metro (Austin’s public transportation authority), that questioned the agency’s “aggressive marketing campaign”. The stated noted that “While some advertisements seem intended to convey basic information, others (such as the radio campaign) seem like political advocacy on behalf of the Regional Mobility Plan’s controversial recommendations.”

As taxpayers and transit advocates, we are concerned about the expenditure of public money for this campaign-related advertising. While the words “vote for the bond package” are not included in any of the advertisements, this sort of technicality prioritizes form over substance: since the rest of the content makes no mention of opposing viewpoints or data, this advertising campaign is public relations, not genuine engagement.

Kyle Keahey, Project Lead for Project Connect’s “Central Corridor”, responded that the ads were ” educational materials” that “are fully compliant with election laws”. He also disclosed that the ads were supported by a budget of more than $157,000. Perhaps small by the mega-million standards of a public transport project, but far more than is available to community organizations questioning Project Connect’s program. And it’s money derived from public tax revenues.

In response, AURA, in a letter from the co-chair officers of its Urban Rail Working Group, reiterated its criticism and concern, particularly “the ethics of spending taxpayer dollars on the political campaign for Project Connect’s urban rail proposal.” AURA focused on the rather suspicious timing for the ad campaign to end:

You also note that the ad buy will conclude on August 5th, two days before City Council is expected to place Project Connect’s road-rail bond measure on the November ballot, at which point the ads would presumably become subject to Texas law regulating the use of public funds for political advertising (Tex. Election Code § 255.003). This information appears to confirm our impression that this is a political advertising campaign, not an “educational and project awareness effort.”

AURA’s letter concludes with a stinging rebuke that seems to convey much of the anger simmering in the Austin community:

You explain that your legal counsel has verified that the advertising campaign is “fully compliant with election laws.” We are confident in your attorneys’ legal opinion on this matter. Unfortunately, we are much less confident that you understand that spending taxpayer dollars promoting a controversial urban rail proposal is unethical and erodes public trust.

We appreciate that Project Connect is “committed to conducting an open, transparent, and legally compliant process.” In the future, we hope you will commit to an ethical one as well.

At least one major media outlet has taken note of the controversy. Time-Warner Cable News, in an Aug. 2nd story titled Urban Rail Ad Campaign Under Fire, noted that, after two months on “Austin airwaves”, the ads promoting urban rail were “wrapping up” … “just as city leaders are about to ask voters to support a tax increase that would help pay for the billion-dollar rail.”

And the reporter turned to AURA for comment:

“It’s very clear that this is a political campaign,” AURA’s Marcus Denton said.

Denton questions the timing of the ads, which all end Wednesday.

“The fact that they are pulling the ads off the air immediately before they’d be subject to election law about ballot measures is very suspicious,” he said.

Denton is with a group that supports urban rail, but not the route leaders chose. He said going to Austin Community College’s Highland Campus will not guarantee the riders needed to support the system.

The report further noted that “Capital Metro and the city of Austin are paying for a combined 20 percent, while the other 80 percent is coming from a federal grant.” It also quoted a representative of the rightwing Texas Public Policy Foundation (TPPF), criticizing the channeling of public funds for the “media blitz”.

“Taxpayers are paying money to the federal government, which is then turning around and lobbying Austinites to support more taxpayer spending” said the TPPF spokesman. “That’s not appropriate.”

In effect, in what seems a somewhat desperate attempt to push the envelope of what’s permissible “educational” activity by a public transit agency, Project Connect may be poisoning the well, so to speak, for more legitimate informational and educational efforts on behalf of more worthy urban rail projects in the future.

h1

Three “incontrovertible facts” about urban rail proposals in Austin

2 August 2014
ACC's map from its own website (annotated by Austin Rail Now) shows ACC campus (marked with inverted blue "teardrop" with MetroRail's Highland station at its northwest corner.

ACC’s map from its own website (annotated by Austin Rail Now) shows ACC campus (marked with inverted blue “teardrop”) with MetroRail’s Highland station at its northwest corner.

By Andrew Clements

The following commentary has been slightly adapted from an original Letter to the Editor published July 21st by the Austin Chronicle.

On June 26th, the City Council endorsed Project Connect’s urban rail line route. Public testimony was limited, but I would have pointed out three incontrovertible facts.

(1) The first is that the approved route terminates at the old Highland Mall, with no plans to extend any further. Every initial line, as part of any transit system, should have plans to be extended, but this one isn’t. Terminating Austin’s initial urban rail line there is proven illogical by no plans to extend it.

(2) And doubly illogical because, second, the entire proposed redevelopment is already served by passenger rail. As shown in ACC’s own map at the top of this post (with annotations by ARN), the Highland station on the MetroRail Red Line is within a half-mile of the entire Highland Mall site – the distance passengers are willing to walk in a transit trip.

Spending hundreds of millions of dollars on a tunnel, and placing new rail on Airport Boulevard (paralleling, only a few feet away, the already existing Red Line passenger rail) to reach a planned redevelopment already served by voter-approved (and funded) passenger rail is a very expensive double service.

Closeup of Highland ACC segment of Project Connect's proposed urban rail map shows how the proposed urban rail line (orange) would effectively duplicate the existing MetroRail Red Line paralleling Airport Blvd. (MetroRail drawn as red line, with Highland station shown as red dot near top of map). Project Connect line would terminate at ACC administration building on far east side of campus, with no plans for extension, and no available corridor for extension. Map: Screenshot by ARN, from Project Connect map.

Closeup of Highland ACC segment of Project Connect’s proposed urban rail map shows how the proposed urban rail line (orange) would effectively duplicate the existing MetroRail Red Line paralleling Airport Blvd. (MetroRail drawn as red line, with Highland station shown as red dot near top of map). Project Connect line would terminate at ACC administration building on far east side of campus, with no plans for extension, and no available corridor for extension. Map: Screenshot by ARN, from Project Connect map.

(3) Third, the projected ridership for the Guadalupe/North Lamar light rail route, considered by voters in 2000, was twice what is proposed now. Higher ridership indicates overall success of a rail line, which means federal funding is more likely, with a likelihood of more voter support of the next urban rail line. Guadalupe and North Lamar is where millions of dollars were spent, in 1999-2000, in an already approved federal study determining where rail should be.

Screenshot from Federal Transit Administration's New Start summary table of Capital Metro's 2000 urban rail (light rail transit) plan. Projected daily ridership (circled in red) of 37,400 is more than double the 18,000 Project Connect claims for its current Highland-Riverside proposal — and more than triple a more realistic figure of 12,000. Annotation: ARN.

Screenshot from Federal Transit Administration’s New Start summary table of Capital Metro’s 2000 Guadalupe-Lamar urban rail (light rail transit) plan. Projected daily ridership (circled in red) of 37,400 is more than double the 18,000 Project Connect claims for its current Highland-Riverside proposal — and more than triple a more realistic figure of 12,000. Annotation: ARN.

Mayor Leffingwell has coined the phrase “rail or fail”. A November referendum will likely fail, because the mayor has unfortunately led a special-interest-dominated effort that has not considered neighborhood and rail advocate voices, but instead a process where the data has been manipulated to a point where the result is anything but objective. Rail advocates like me hope that following a likely November referendum failure, we can immediately begin planning, and achieving, rail on Guadalupe/North Lamar. ■
